Construction Progress

Cordial Leora Construction Status: Work Progress Updates

Regular Cordial Leora work progress updates with photographs, as per RERA compliance requirements. All updates are dated and verified.

RERA Registration
K-RERA/PRJ/TVM/215/2024
Verify at rera.kerala.gov.in ↗
Project Type
Lower Ground 1 and 2 + Ground + 15 floors
54 apartments, 2, 3 & 4 BHK
Location
Kuravankonam, Kowdiar
Trivandrum, Kerala
Last Updated
September 2026
Monthly updates

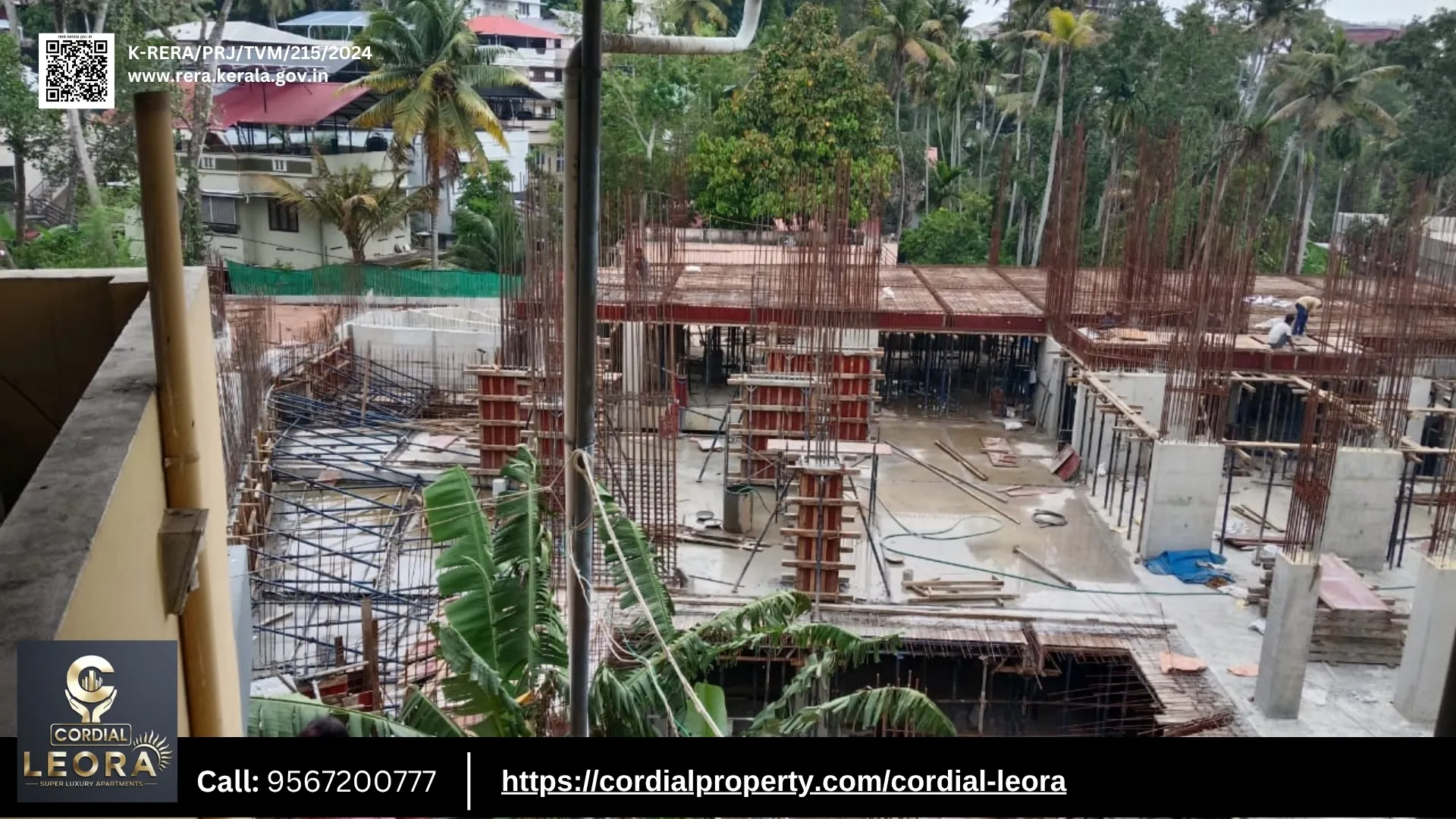

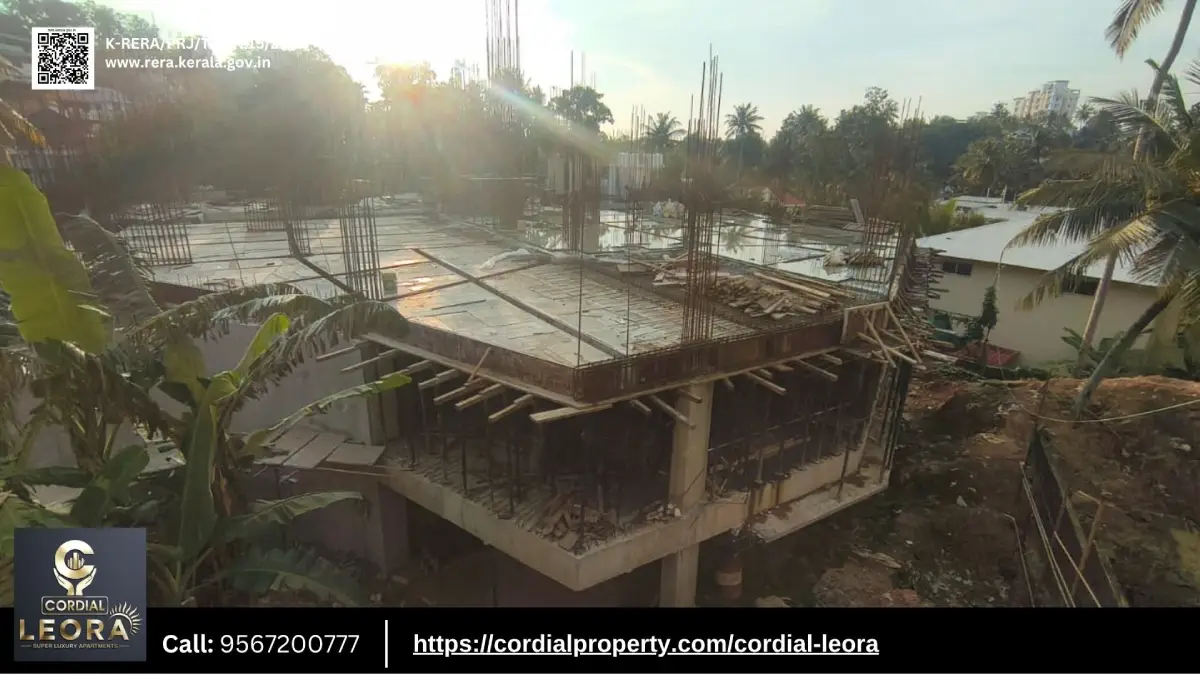

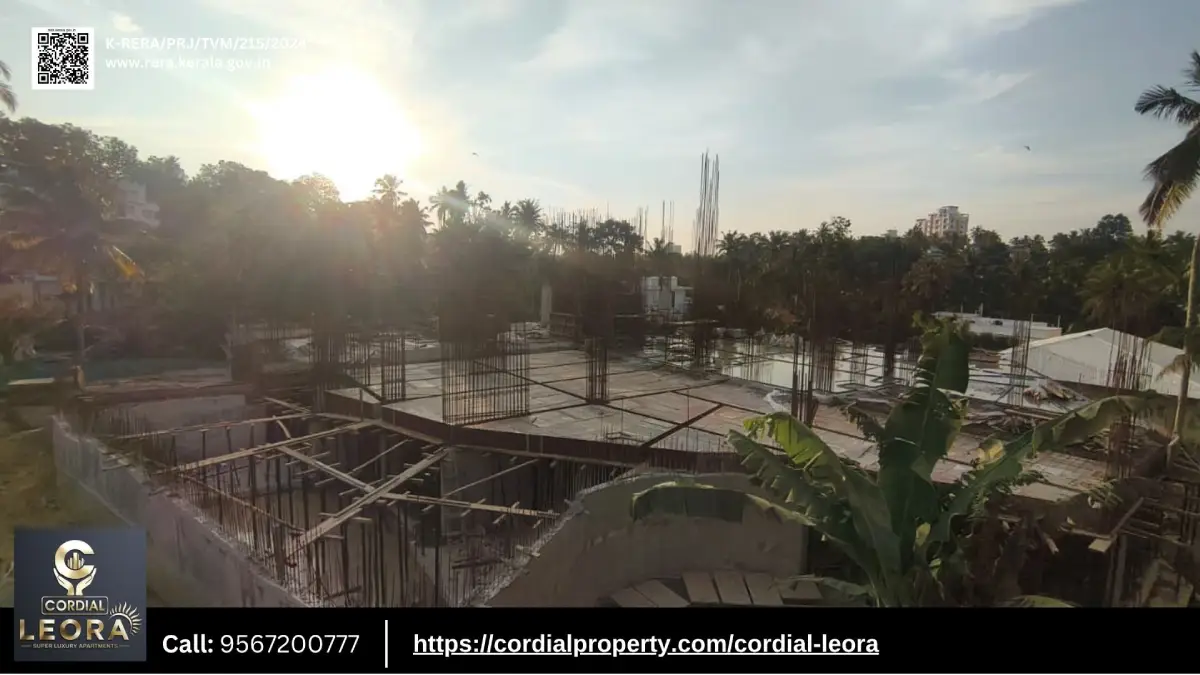

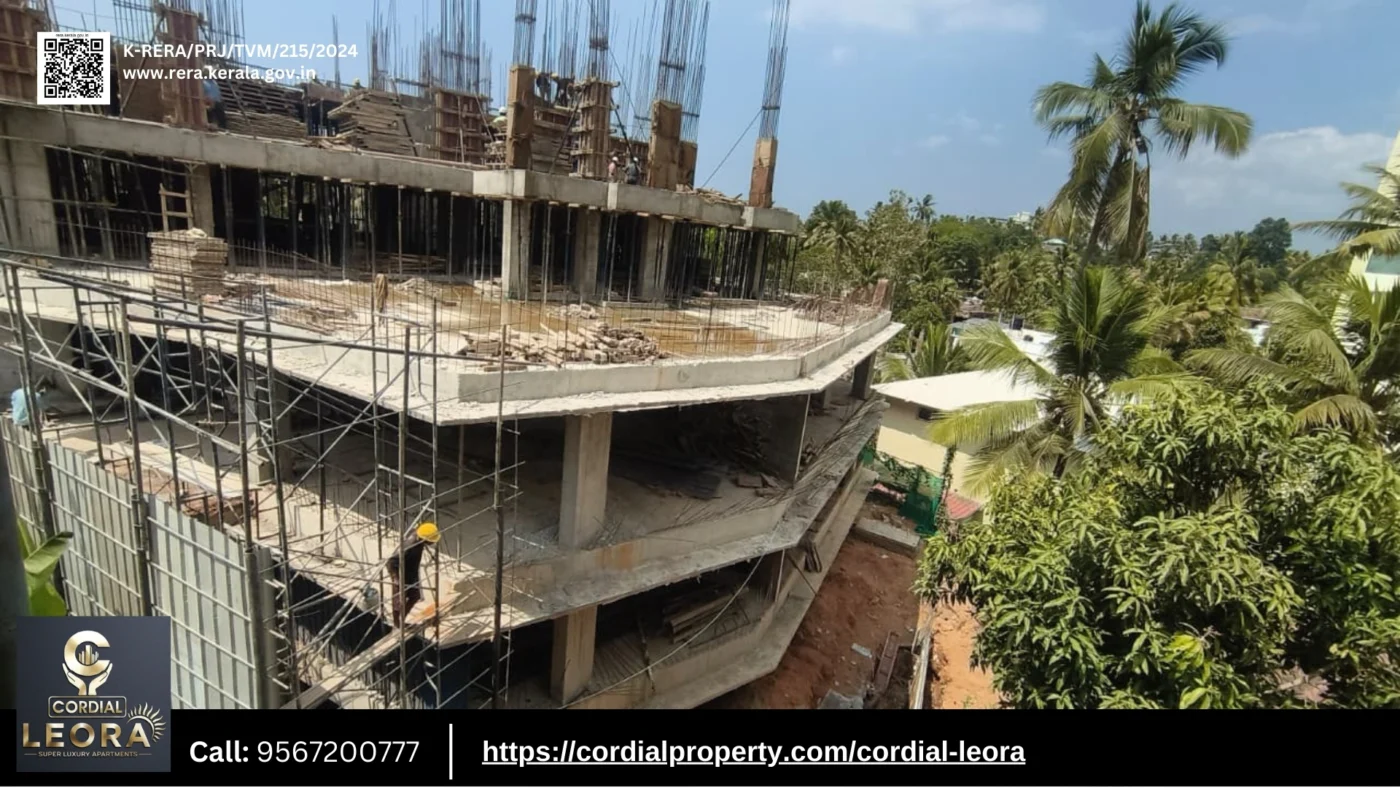

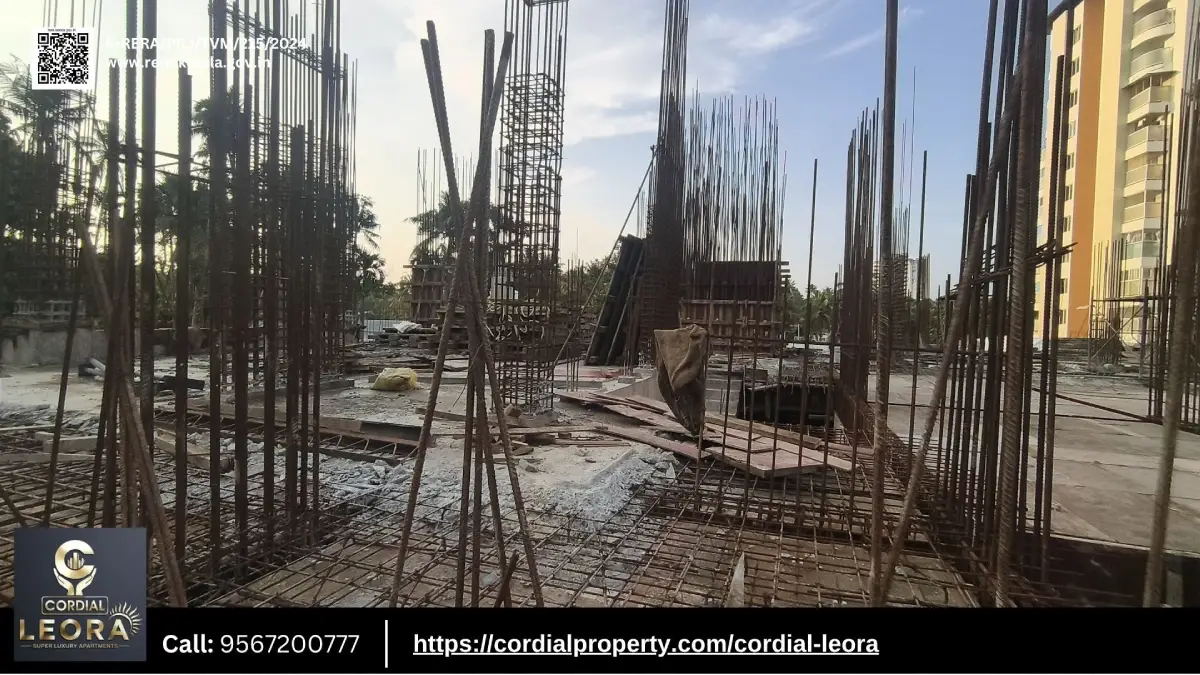

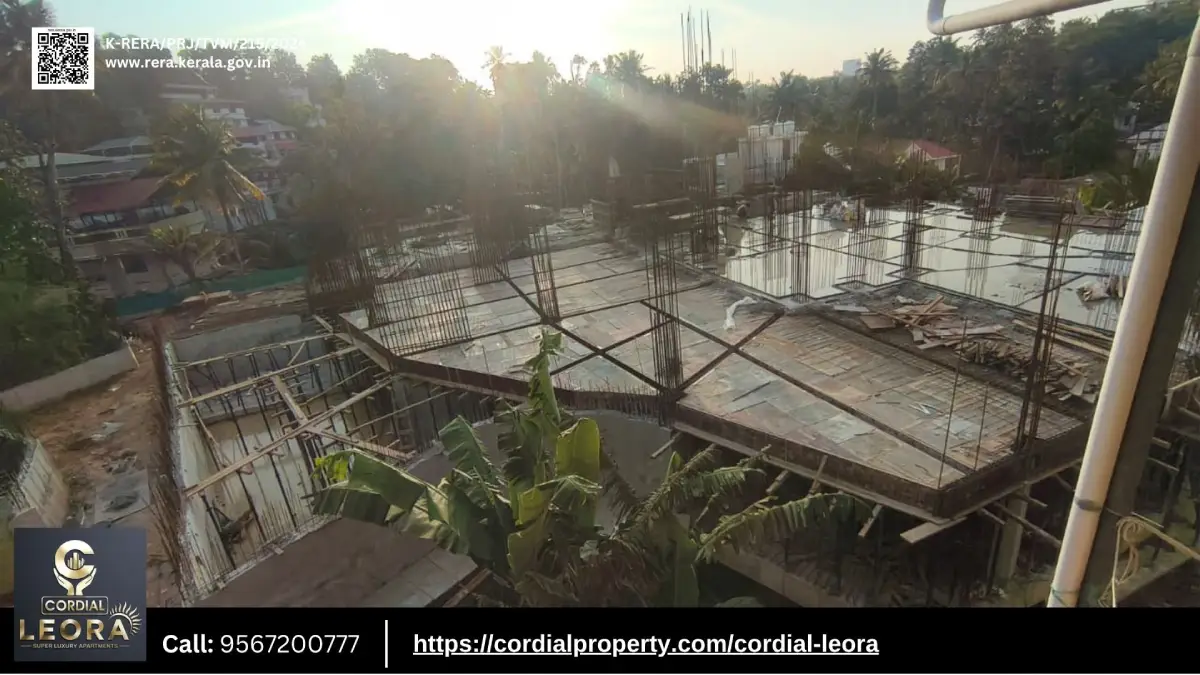

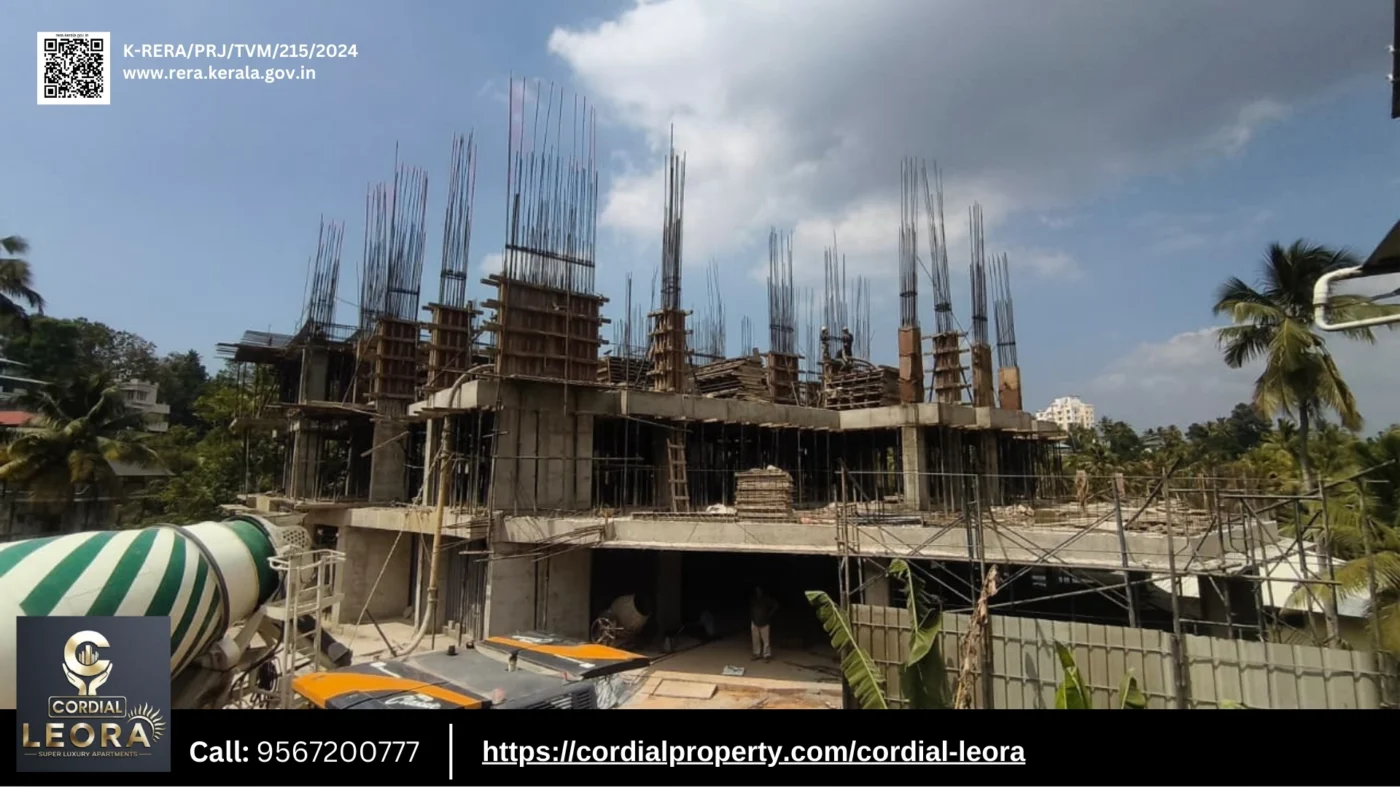

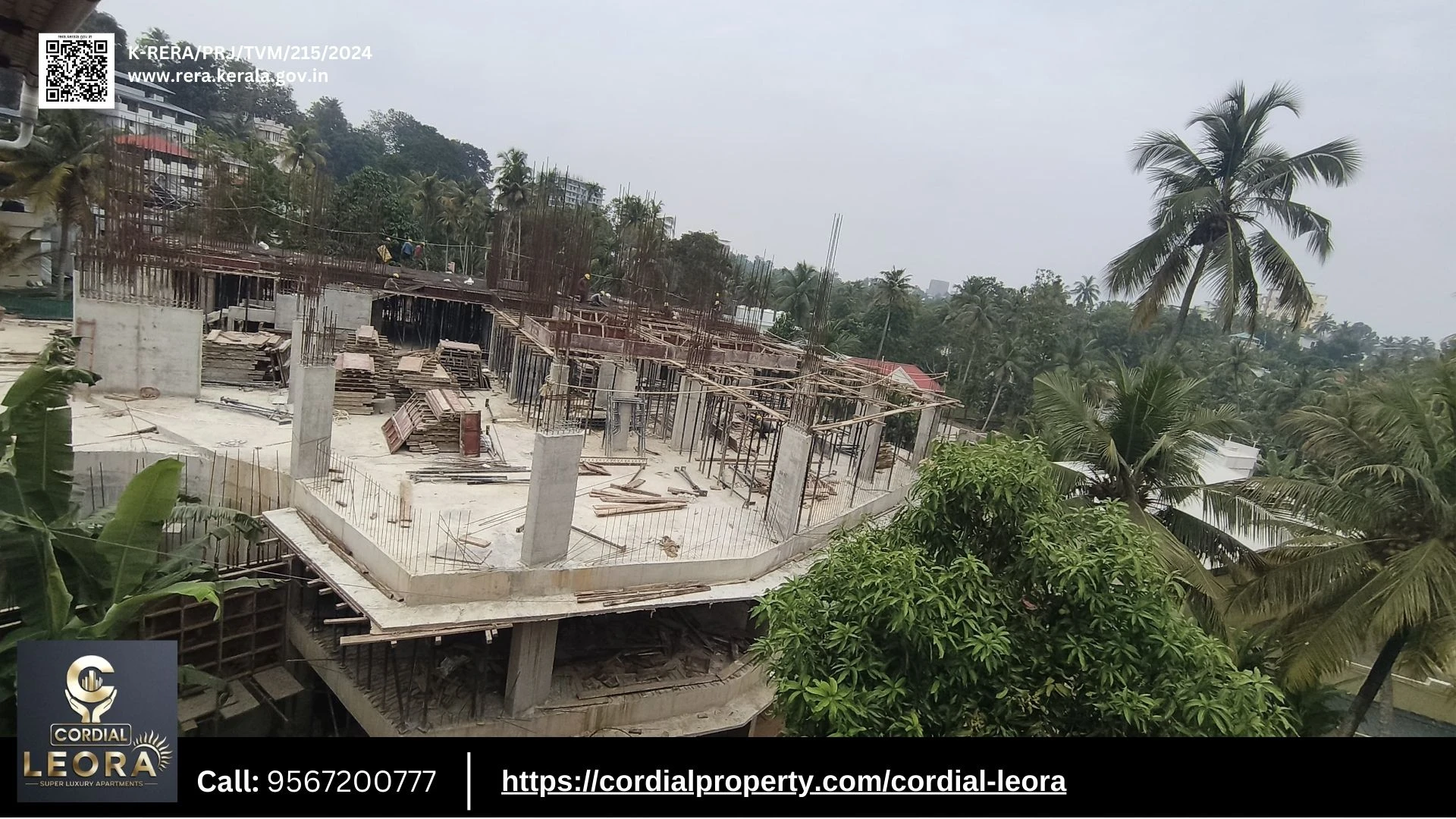

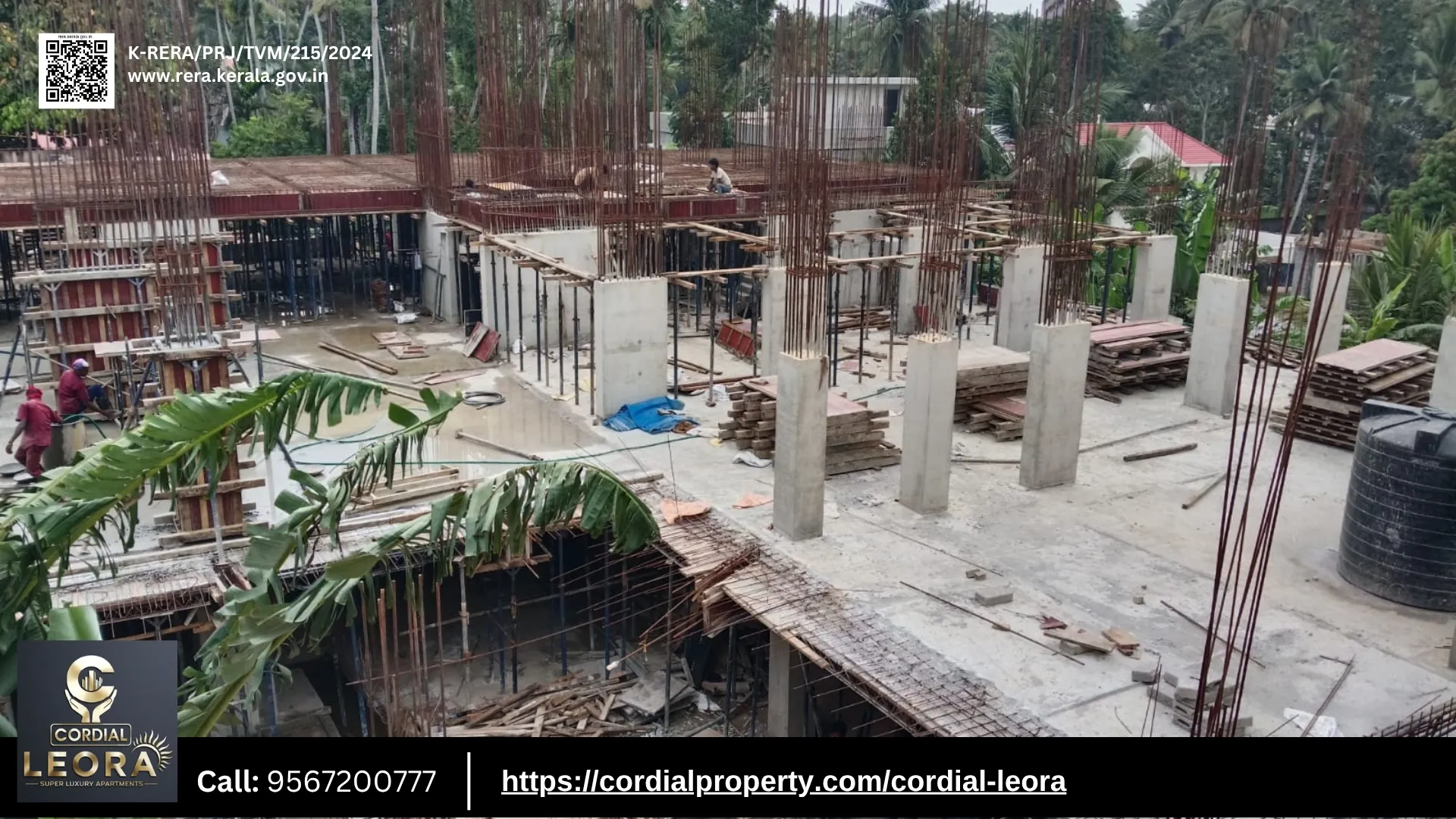

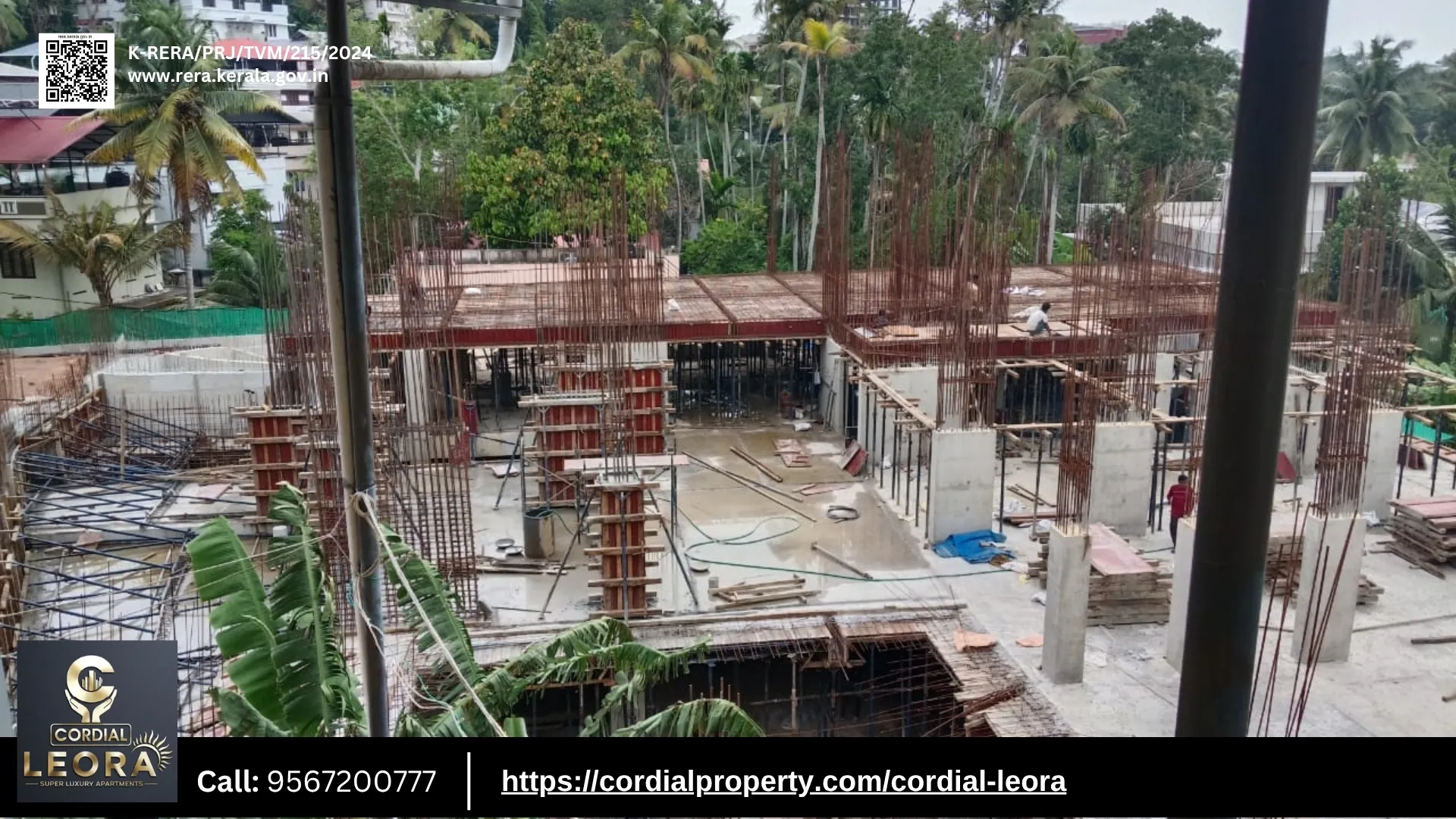

Work status as of October 2026
Sl.NoWork descriptionStatus
1Retaining wall worksCompleted

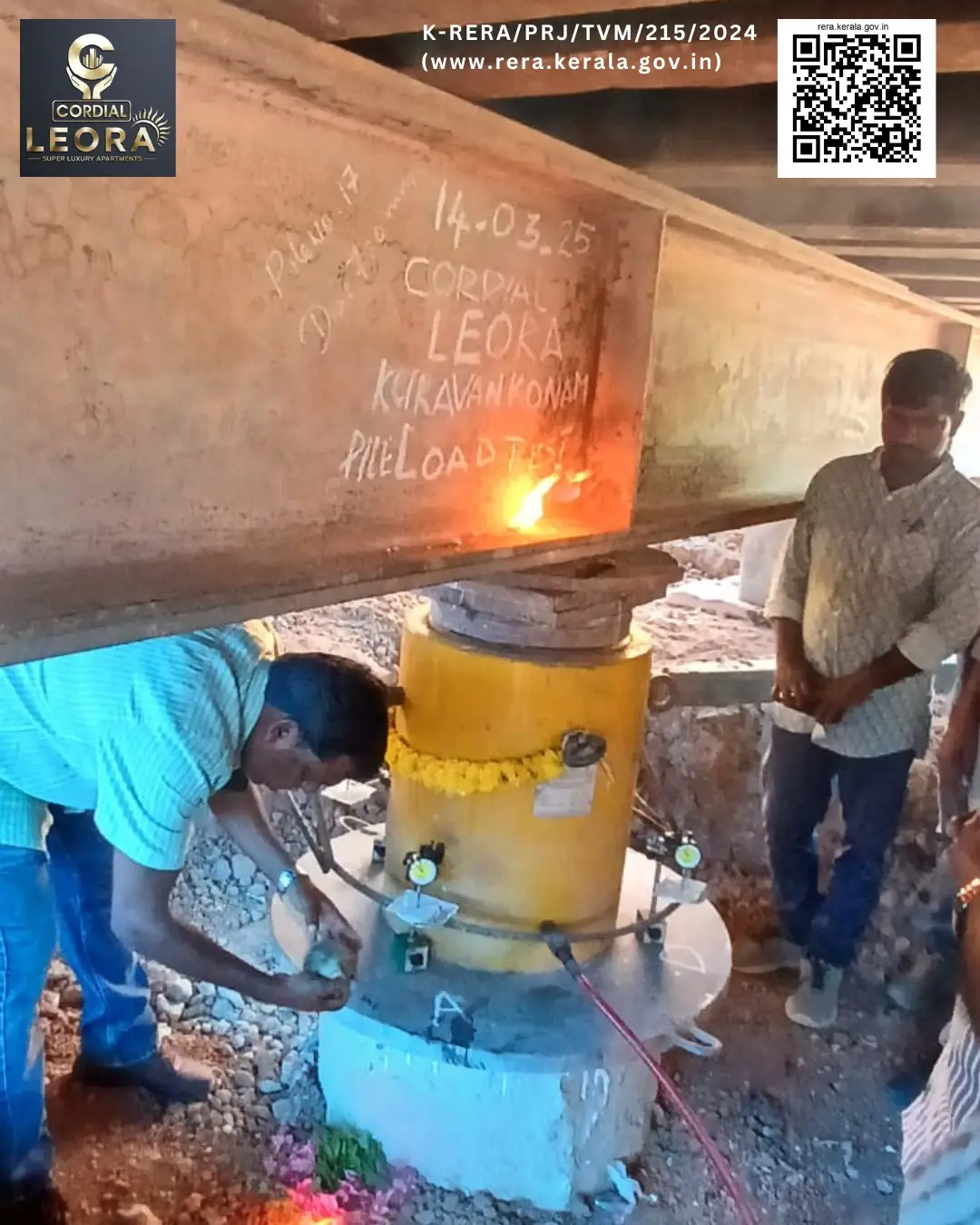

2Piling workCompleted
3Foundation including pile cap, grade beam and grade slab workCompleted
4#Column workIn Progress
5Lower Ground 2 to Lower Ground 1Completed
6Lower Ground 1 to Ground FloorCompleted
7Ground Floor to First FloorCompleted
8First Floor to Second FloorCompleted
9Second Floor to Third FloorCompleted
10Third Floor to Fourth FloorCompleted
11Fourth Floor to Fifth FloorCompleted
12Fifth Floor to Sixth FloorCompleted
13Sixth Floor to Seventh FloorCompleted
14Seventh Floor to Eighth FloorCompleted
15Eighth Floor to Ninth FloorCompleted
16Ninth Floor to Tenth FloorCompleted
17Tenth Floor to Eleventh FloorCompleted
18Sump tankCompleted
19Lift pit workCompleted
20#Ramp concreteIn Progress
21(Lower Ground 2 to Lower Ground 1)Completed
22Ramp concrete (Lower Ground 1 to Ground Floor)Completed
23#slab workIn Progress
24Lower Ground 1 floor slabCompleted
25Ground floor slabCompleted
26First floor slabCompleted
27Second floor slabCompleted
28Third floor slabCompleted
29Fourth floor slabCompleted
30Fifth floor slabCompleted
31Sixth floor slabCompleted
32Seventh floor slabCompleted
33Eighth floor slabCompleted
34Ninth floor slabCompleted
35Tenth floor slabCompleted
36Eleventh floor slabIn Progress
37#Ceiling plasteringIn Progress
38First FloorCompleted
39Second FloorCompleted
40Third FloorCompleted
41Fourth FloorCompleted
42Fifth FloorCompleted
43Sixth FloorCompleted
44Seventh FloorCompleted
45Eighth FloorIn Progress
46#Block workIn Progress
47First FloorCompleted
48Block work (Second Floor)Completed
49Block work (Third Floor)Completed
50Block work (Fourth Floor)Completed
51Block work (Fifth Floor)In Progress
52Block work (Eighth Floor)In Progress
53#Inside plasteringIn Progress
54First Floor)Completed
55Second FloorCompleted
56Third FloorIn Progress
57#Electrical workIn Progress
58First Floor – Wall chasing and box fixingCompleted
59Second Floor – Wall chasing and box fixingCompleted
60Third Floor – Wall chasing and box fixingCompleted
61Fourth Floor – Wall chasing and box fixingIn Progress
62#Painting workIn Progress
63First Floor – Putty workIn Progress

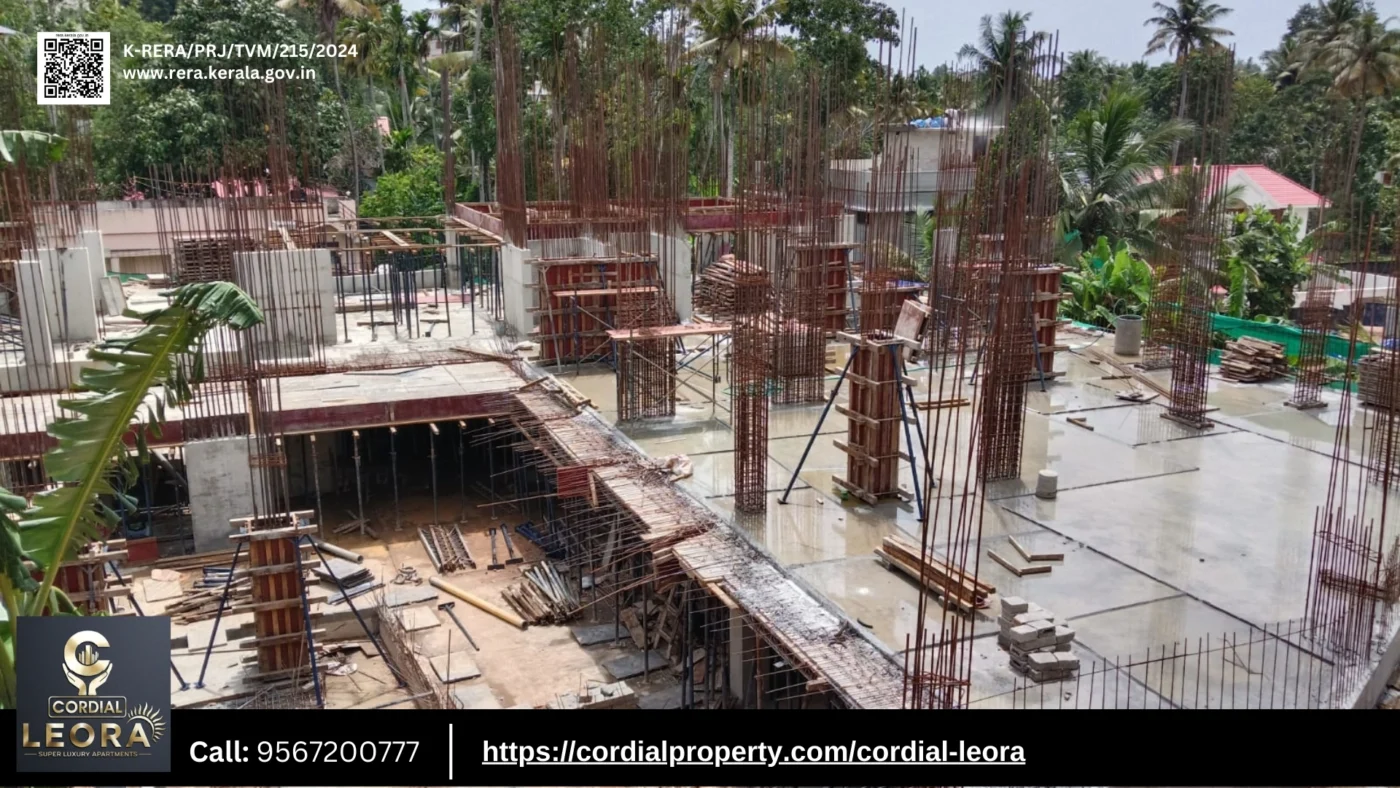

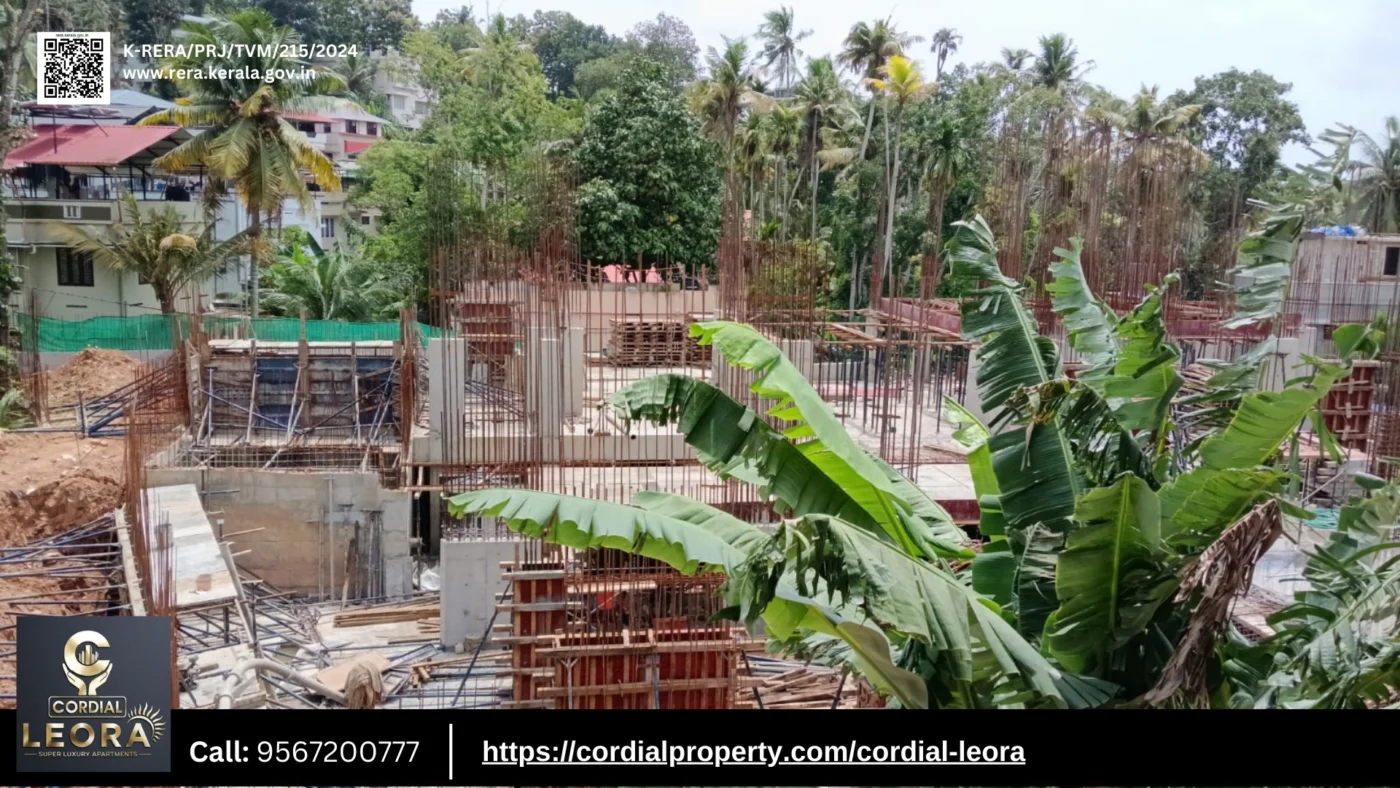

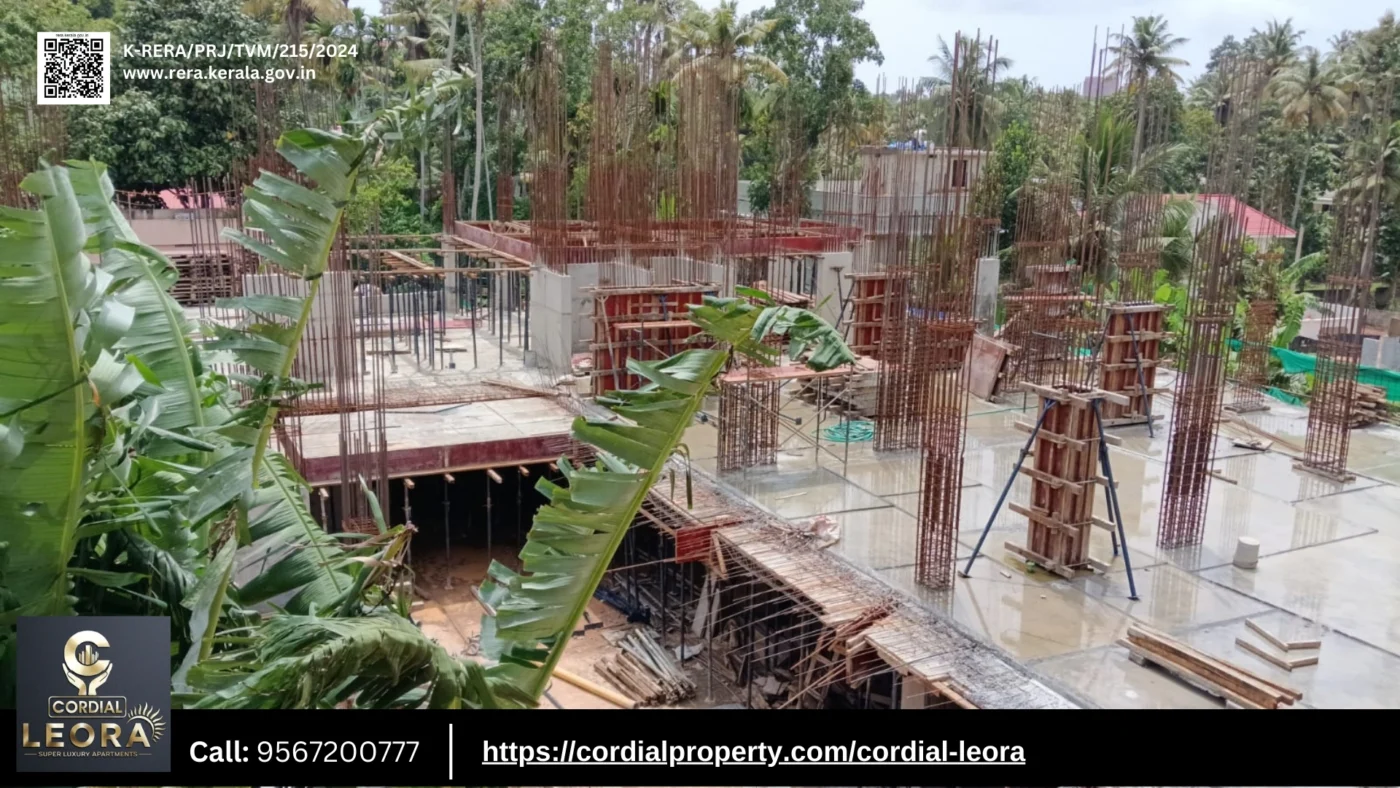

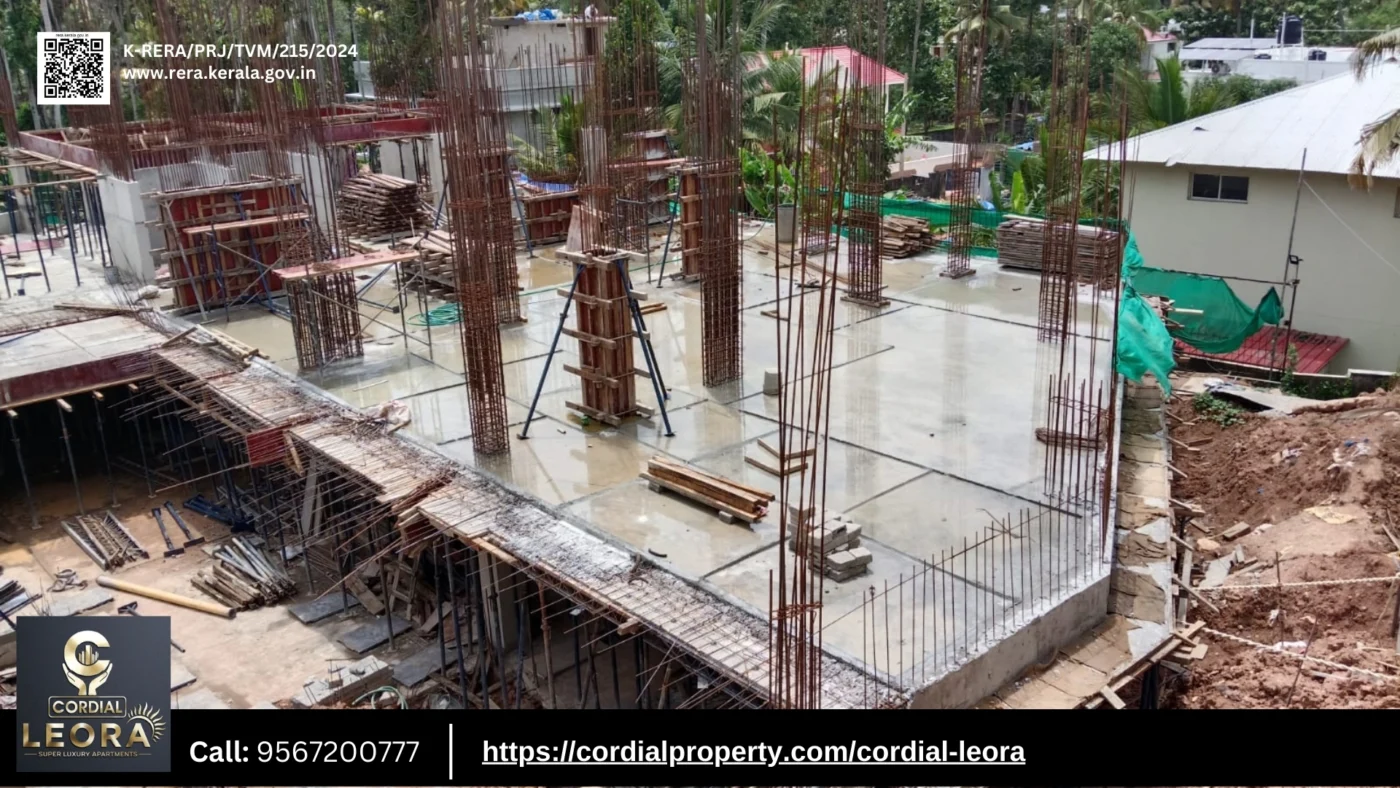

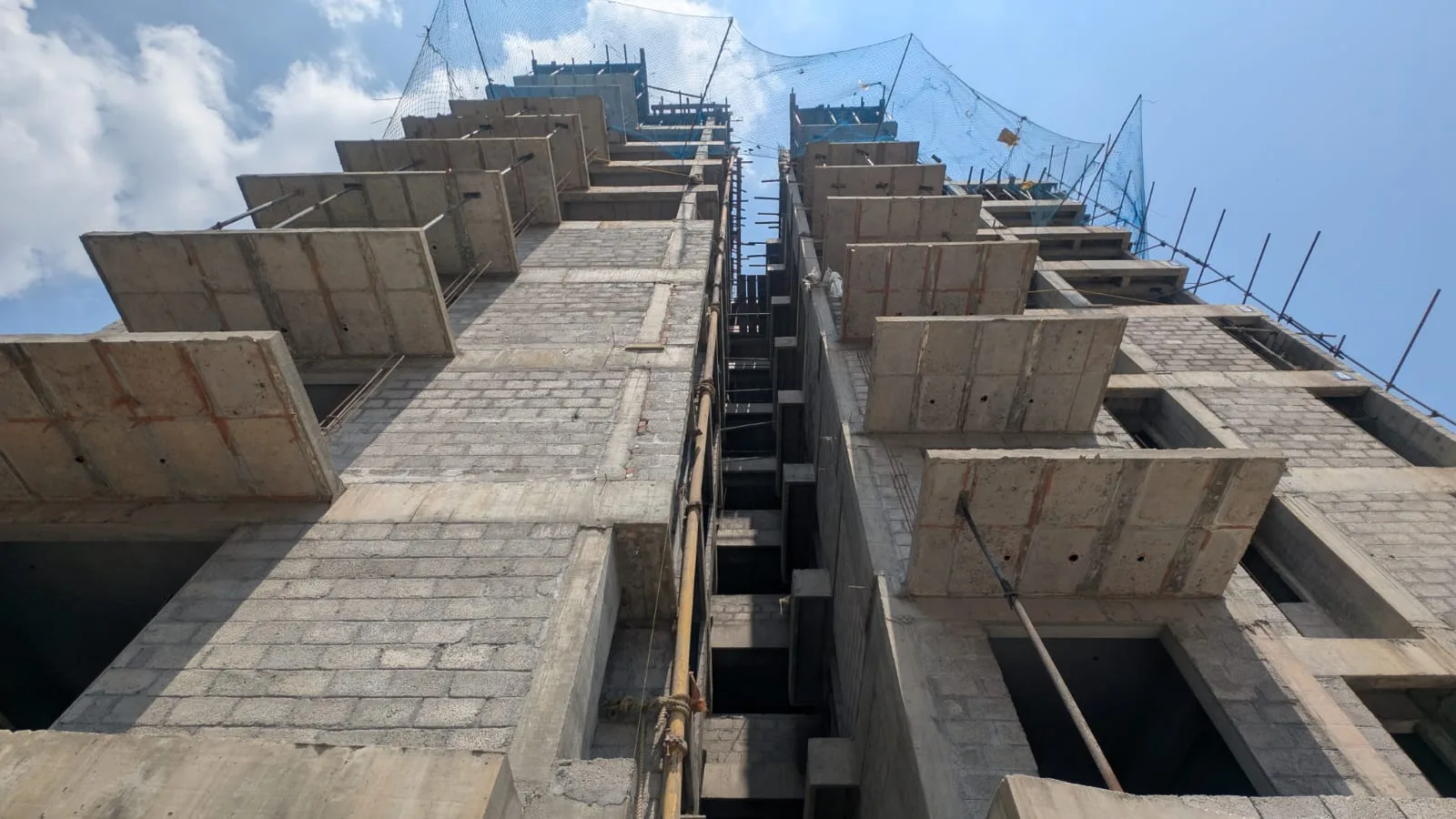

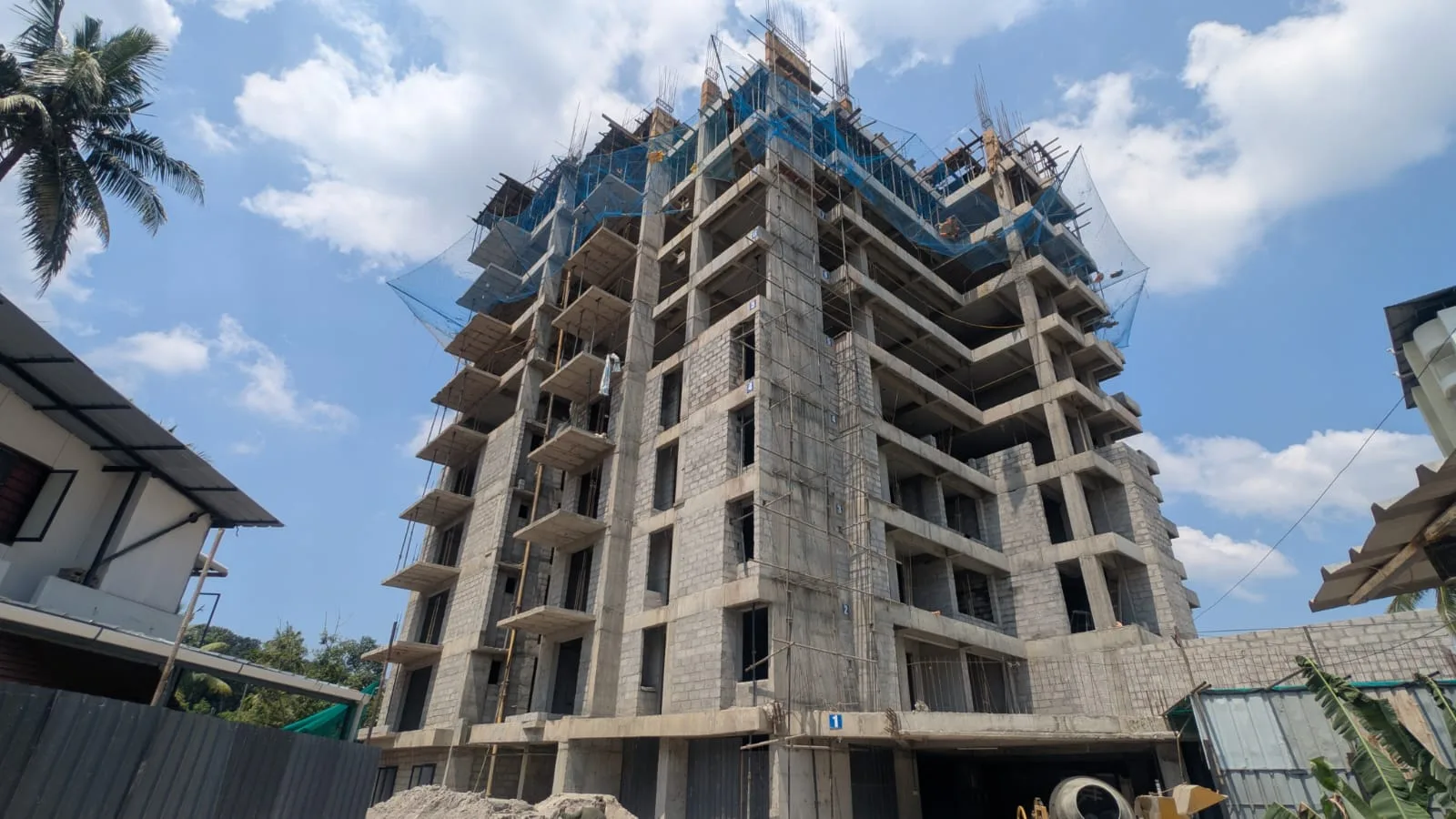

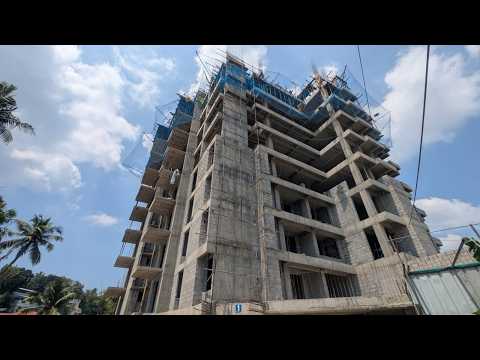

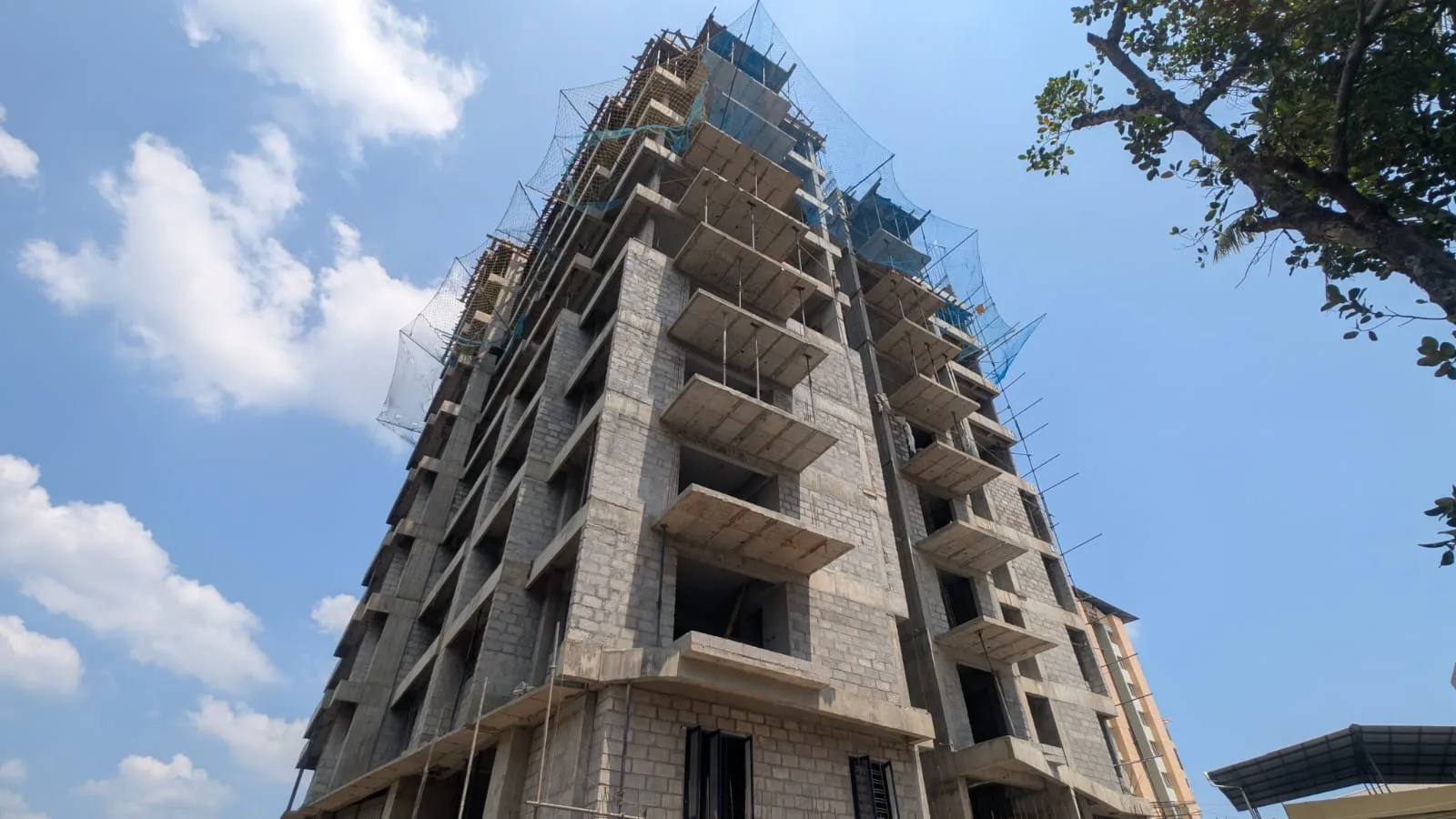

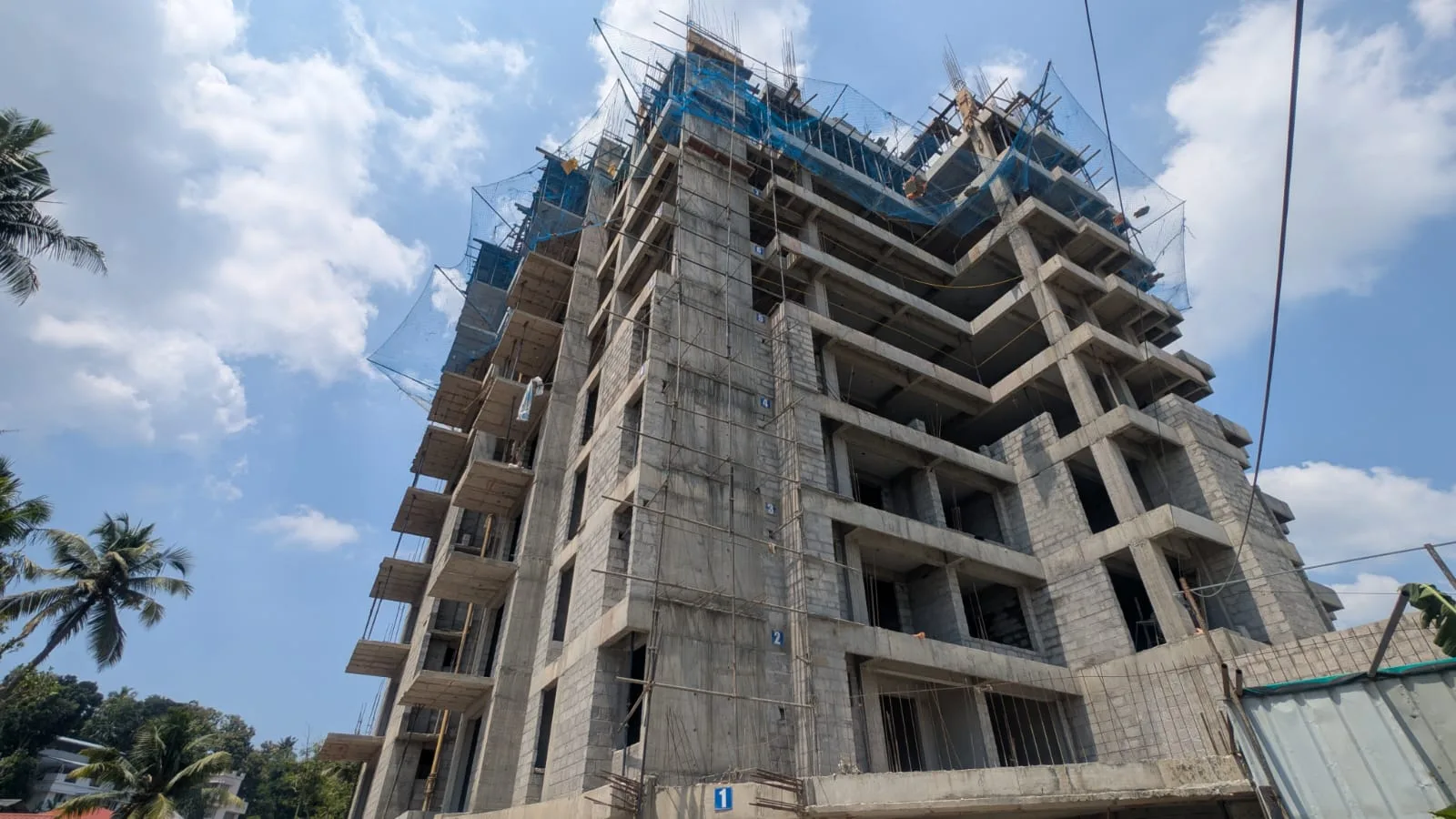

Works status as of September 2026
Sl.NoWork descriptionStatus
1Retaining wall worksCompleted
2Piling workCompleted
3Foundation including Pile cap, Grade beam and Grade slab workCompleted
4#Column workIn Progress
5Lower ground 2 to Lower ground 1Completed
6Lower ground 1 to Ground flooCompleted
7Ground floor to First floorCompleted
8First floor to Second floorCompleted
9Second floor to third floorCompleted
10Third floor to 4th floorCompleted
114th floor to 5th floorCompleted
125th floor to 6th floorCompleted
136th floor to 7th floorCompleted
147th floor to 8th floorCompleted
158th floor to 9th floorCompleted
169th floor to 10th floorCompleted
17Sump tankCompleted
18Lift pit workCompleted
19#Ramp concreteIn Progress
20Lower ground 2 to Lower ground 1Completed
21Lower ground 1 to Ground floorCompleted
22#slab workIn Progress
23Lower ground 1 floor slabCompleted
24Ground floor slabCompleted
25First floor slabCompleted
26Second floor slabCompleted
27Third floor slabCompleted
284th Floor slabCompleted
295th Floor slabCompleted
306th Floor slabCompleted
317th Floor slabCompleted
328th Floor slabCompleted
339th Floor slabCompleted
3410th Floor slabIn Progress
35#Ceiling PlasteringIn Progress
36First floorCompleted
37Second floorCompleted
38Third floorCompleted
394th FloorCompleted
405th FloorCompleted
416th FloorIn Progress
42#Block workIn Progress
43First floorCompleted
44Second floorCompleted
45Third floorCompleted
464th Floor (70% completed)In Progress
47#Inside PlasteringIn Progress
48First floorCompleted
49Second floorIn Progress
50Third floorIn Progress
51#Electrical workIn Progress
521st floor Wall chasing and box fixingCompleted
532nd floor Wall chasing and box fixing(70% Completed)In Progress
543rd floor Wall chasing and box fixingCompleted

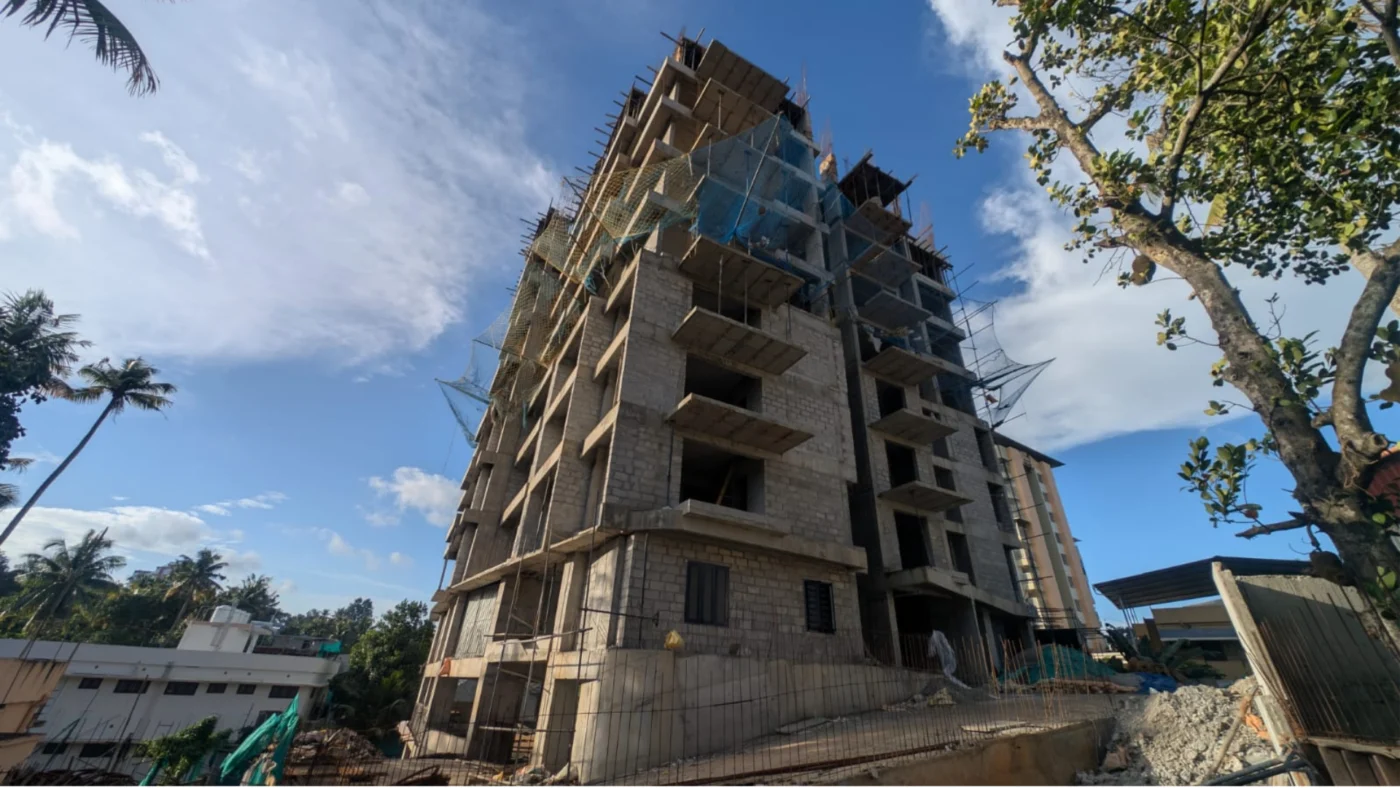

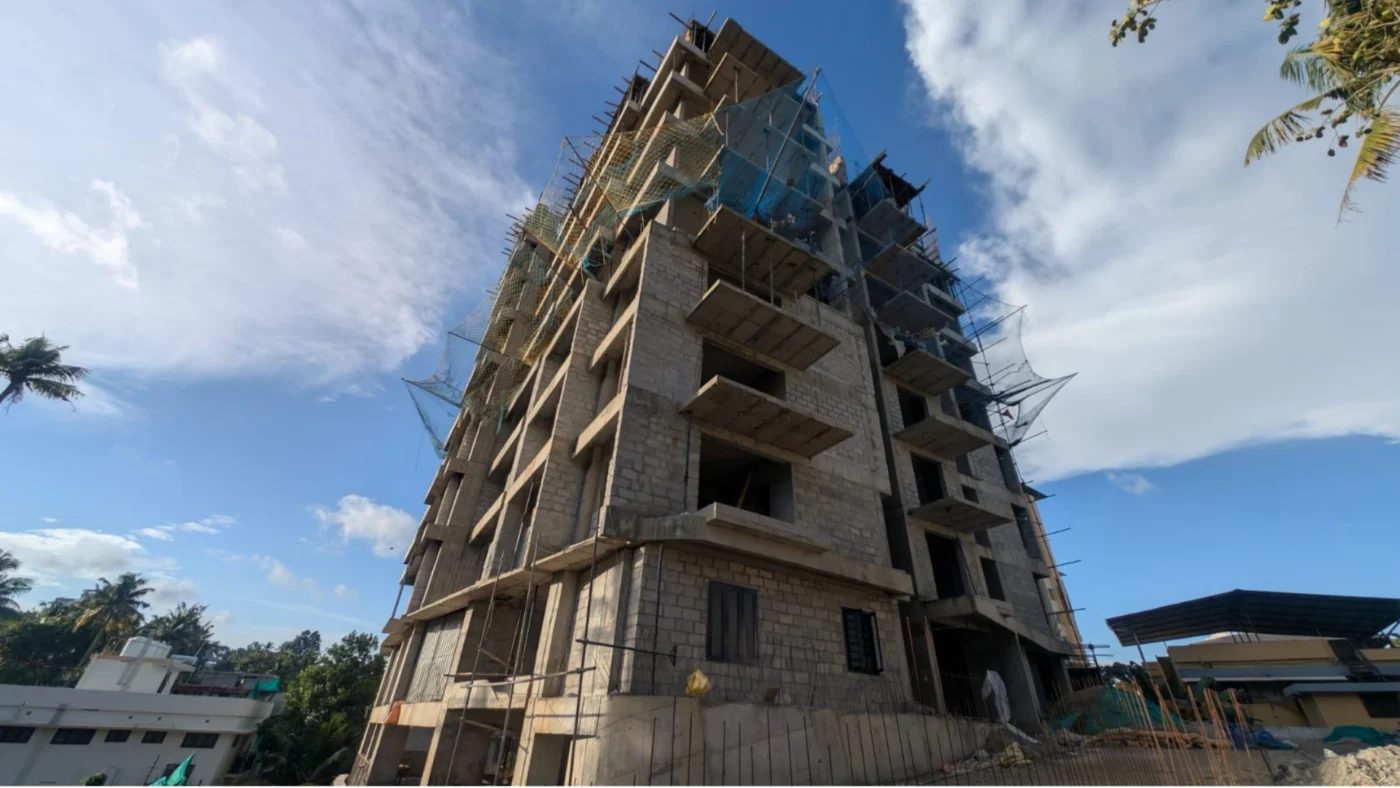

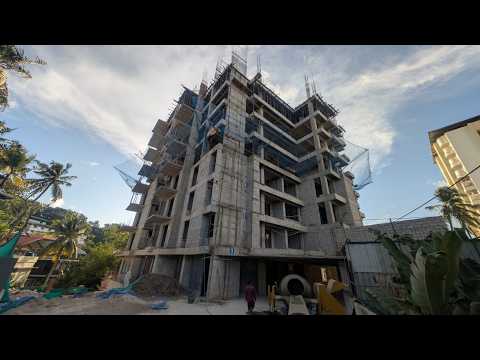

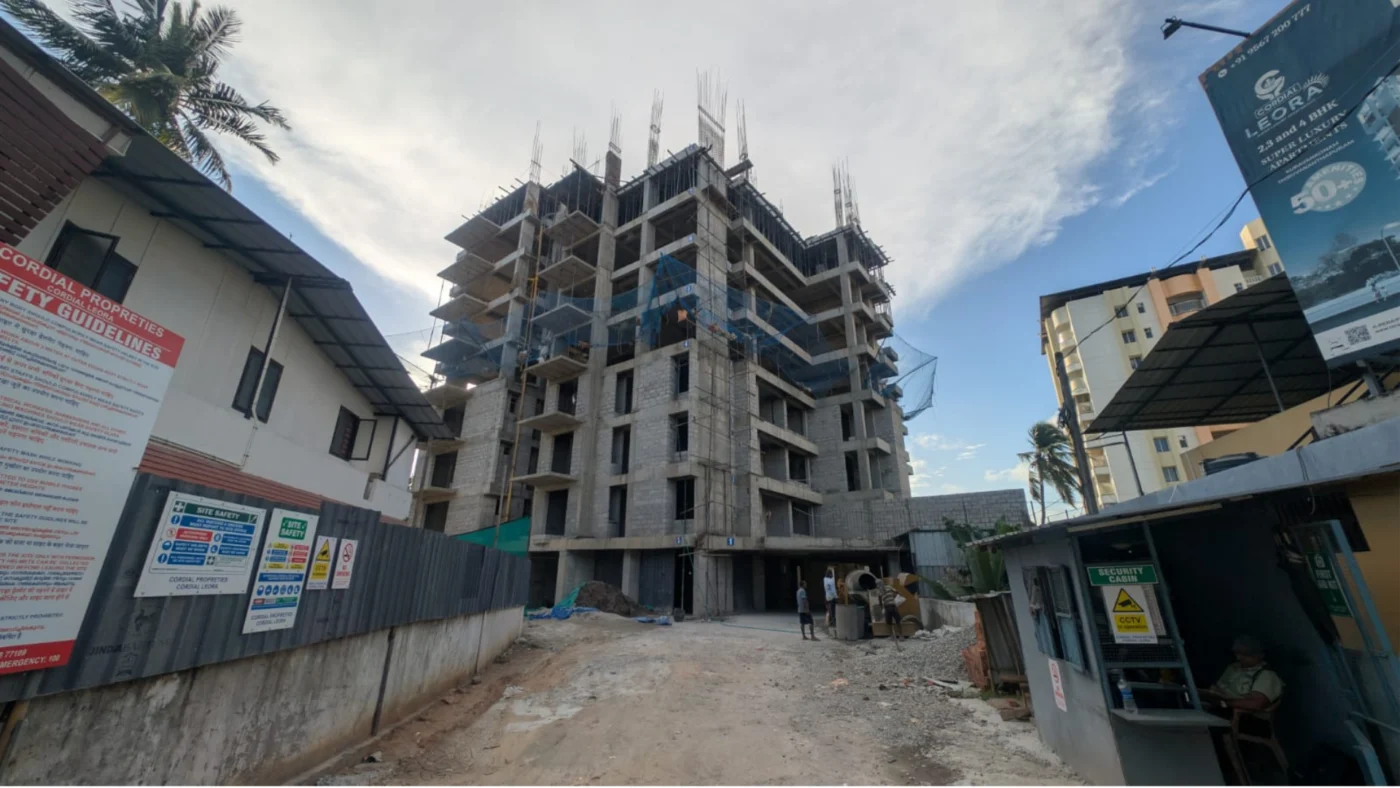

Works status as of August 2026
Sl.NoWork descriptionStatus
1Retaining wall worksCompleted
2Piling workCompleted
3Foundation including Pile cap, Grade beam and Grade slab workCompleted
4# Column workIn Progress
5- Lower ground 2 to Lower ground 1Completed
6- Lower ground 1 to Ground floorCompleted
7- Ground floor to First floorCompleted
8- First floor to Second floorCompleted
9- Second floor to Third floorCompleted
10- Third floor to 4th floorCompleted
11- 4th floor to 5th floorCompleted
12- 5th floor to 6th floorCompleted
13- 6th floor to 7th floorCompleted
14- 7th floor to 8th floorCompleted
15- 8th floor to 9th floor (80% Completed)In Progress
16Sump tankCompleted
17Lift pit workCompleted
18# Ramp concreteIn Progress
19- Lower ground 2 to Lower ground 1Completed
20- Lower ground 1 to Ground floorCompleted
21# Slab workIn Progress
22- Lower ground 1 floor slabCompleted
23- Ground floor slabCompleted
24- First floor slabCompleted
25- Second floor slabCompleted
26- Third floor slabCompleted
27- 4th Floor slabCompleted
28- 5th Floor slabCompleted
29- 6th Floor slabCompleted
30- 7th Floor slabCompleted
31- 8th Floor slabCompleted
32- 9th Floor slabIn Progress
33# Ceiling PlasteringIn Progress
34- First floorCompleted
35- Second floorCompleted
36- Third floorCompleted
37- 4th FloorCompleted
38- 5th FloorIn Progress
39# Block workIn Progress
40- First floorCompleted
41- Second floorCompleted
42- Third floorCompleted
43- 4th FloorIn Progress
44# Inside PlasteringIn Progress
45- 1st floor (90% completedIn Progress
46# Electrical workIn Progress
47- 1st floor Wall chasing and box fixingCompleted
48- 2nd floor Wall chasing and box fixingIn Progress
49- 3rd floor Wall chasing and box fixingIn Progress

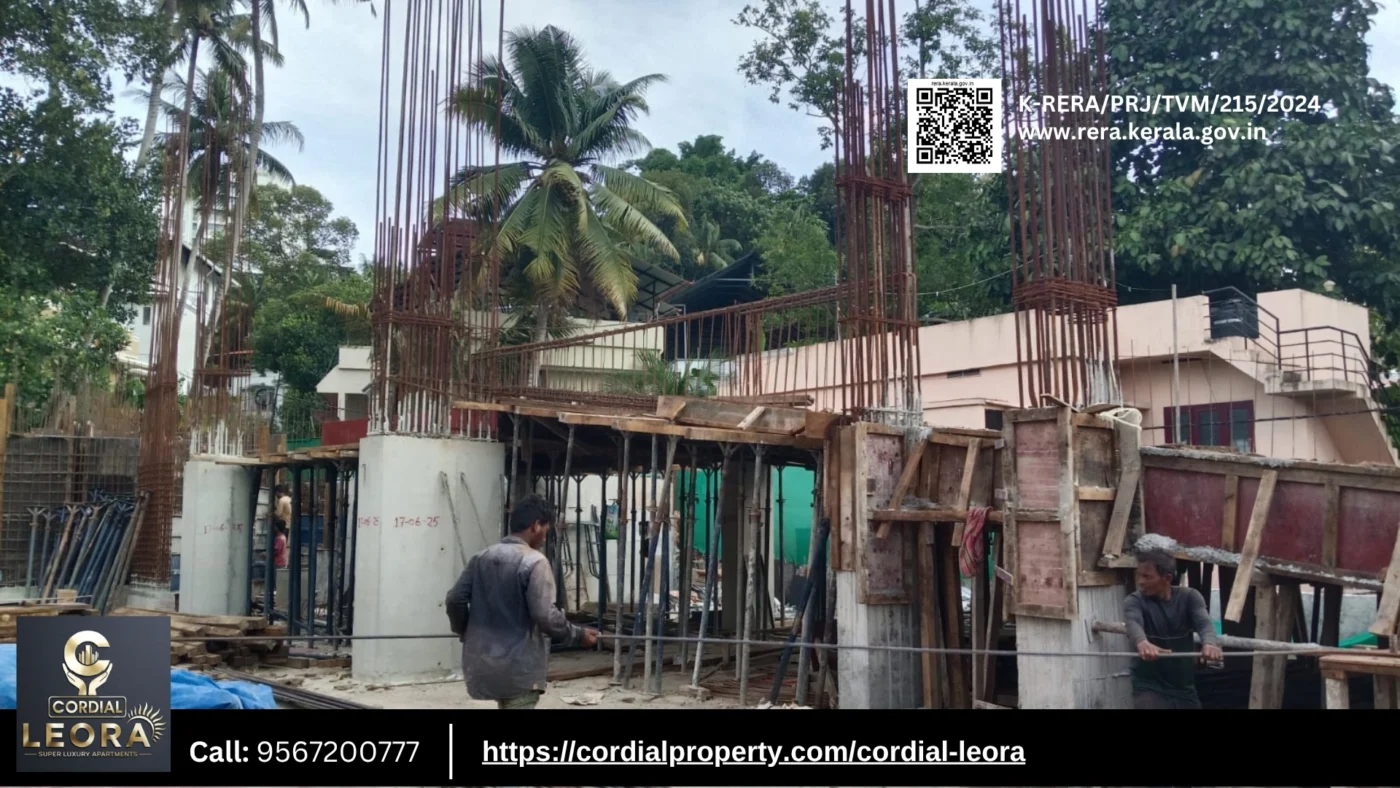

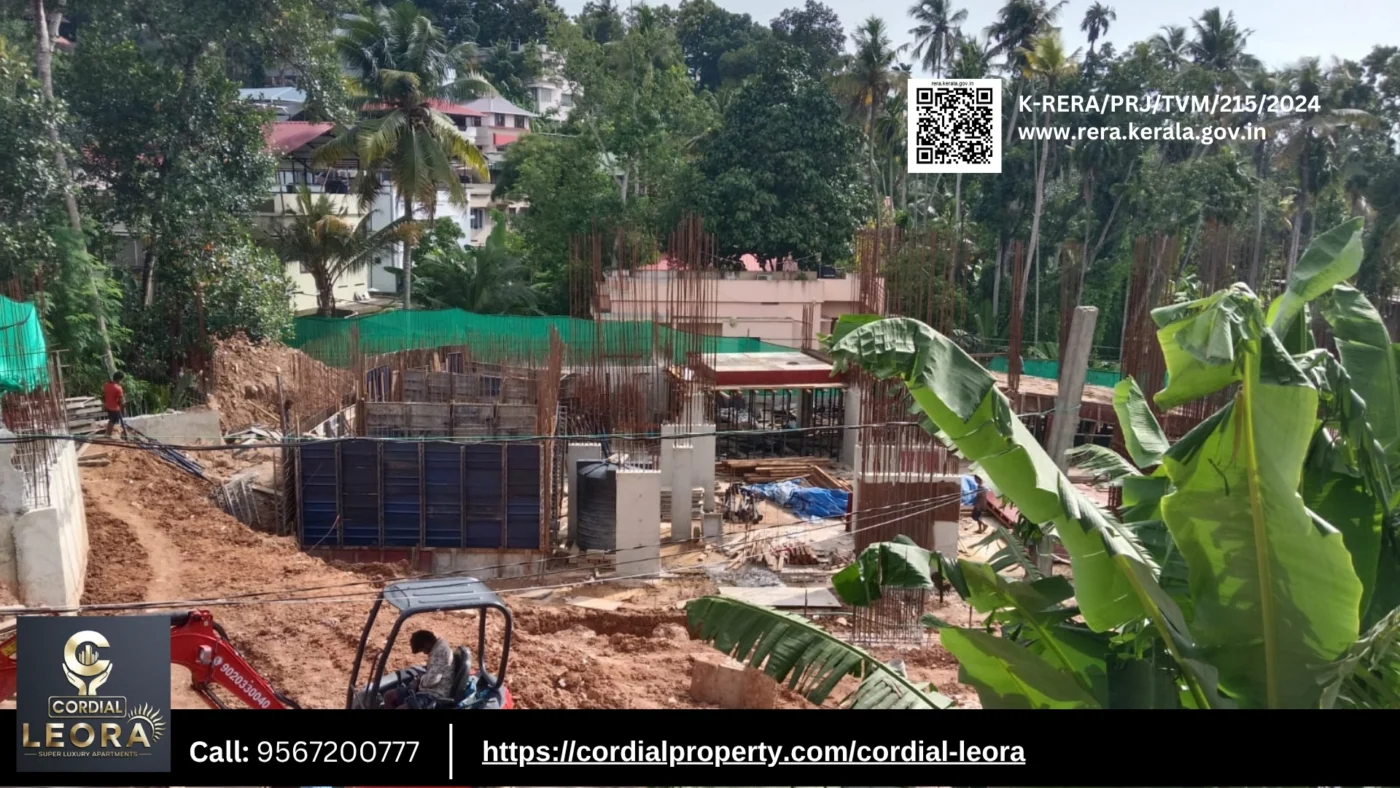

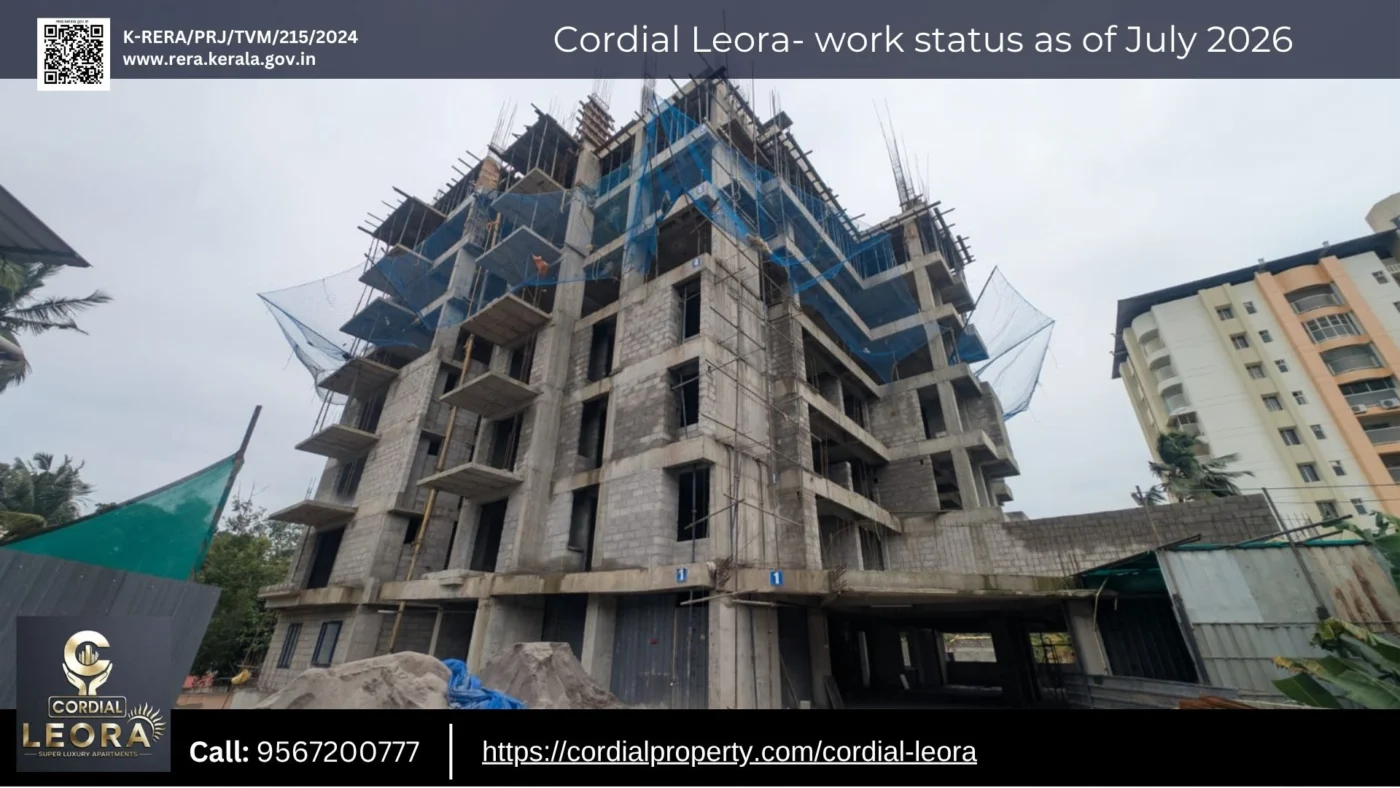

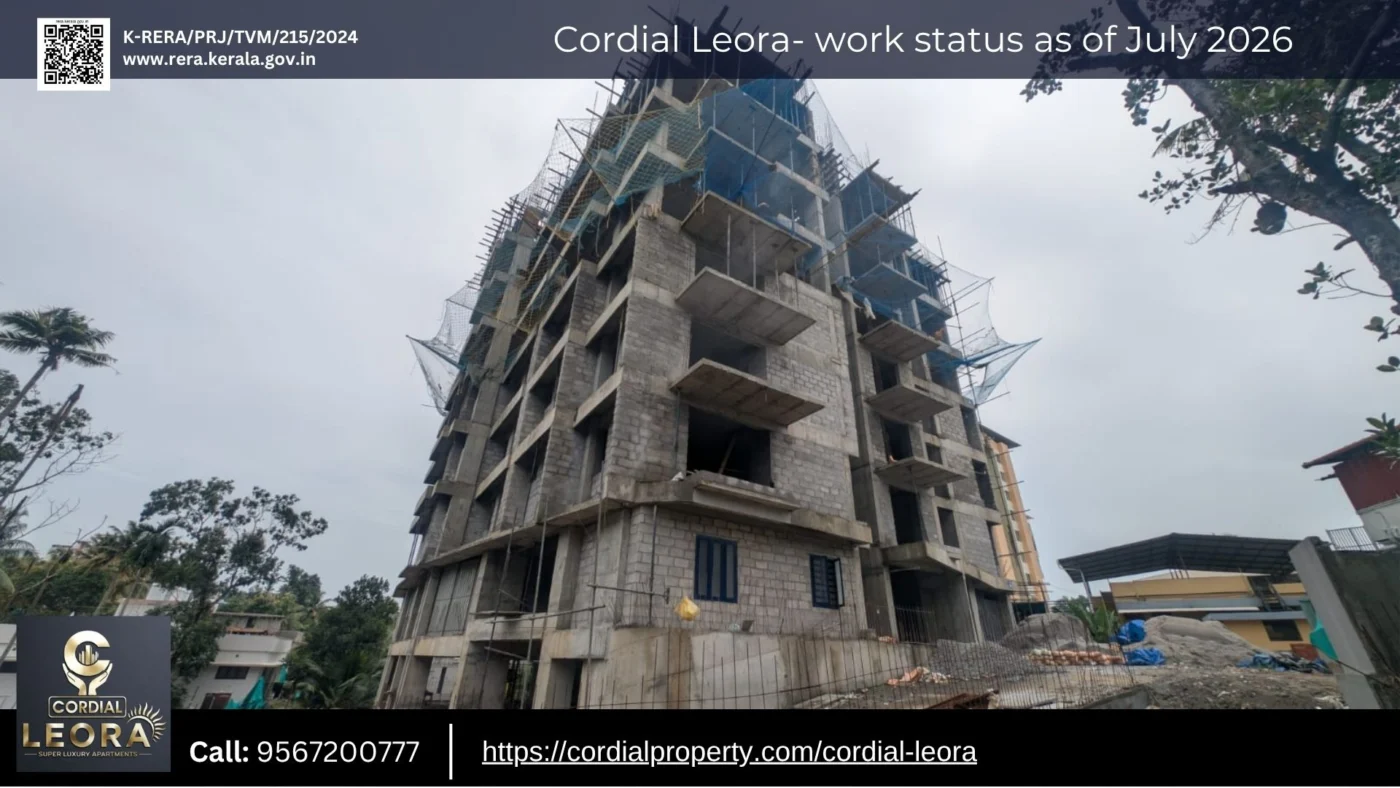

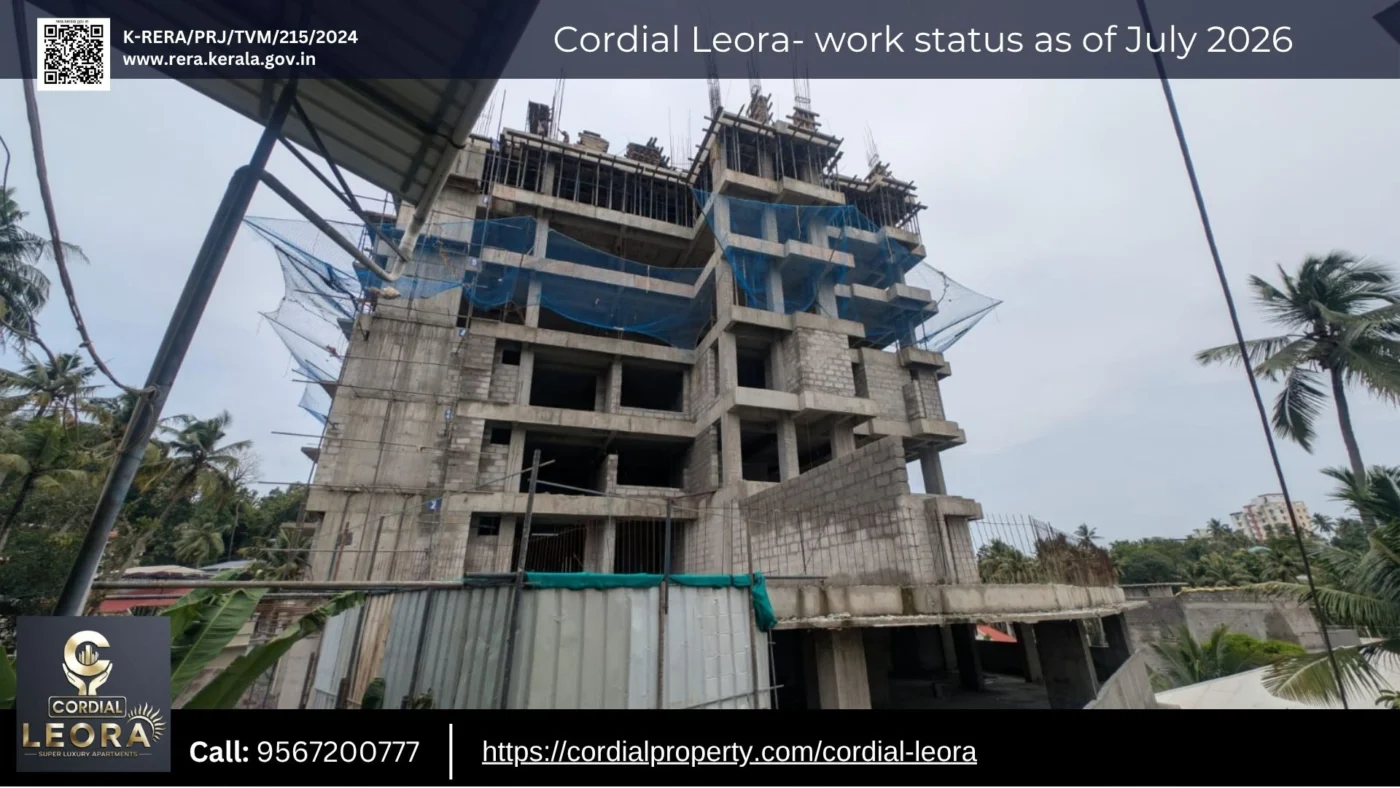

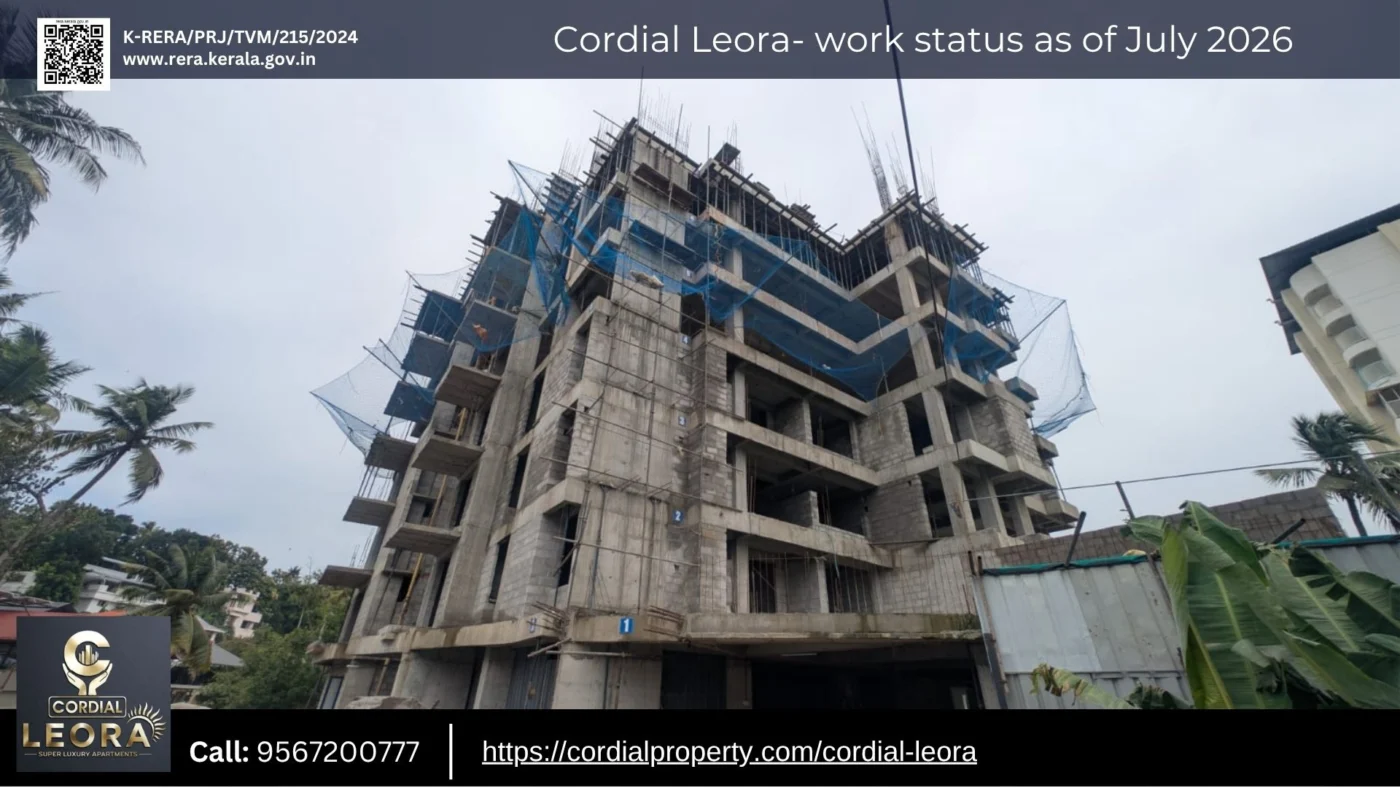

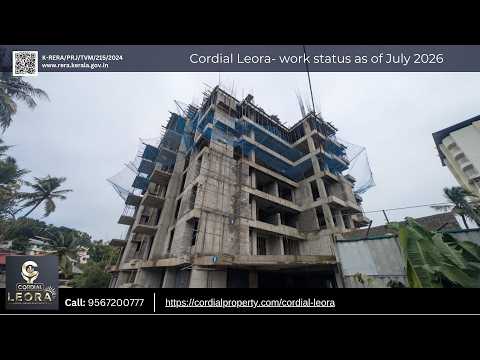

Status as on July 31, 2026
Sl.NoWork descriptionStatus
1Retaining wall worksCompleted
2Piling workCompleted
3Foundation including Pile cap, Grade beam and Grade slab workCompleted
4# Column workIn Progress
5- Lower ground 2 to Lower ground 1Completed
6- Lower ground 1 to Ground floorCompleted
7- Ground floor to First floorCompleted
8- First floor to Second floorCompleted
9- Second floor to Third floorCompleted
10- Third floor to 4th floorCompleted
11- 4th floor to 5th floorCompleted
12- 5th floor to 6th floorCompleted
13- 6th floor to 7th floorCompleted
14- 7th floor to 8th floorCompleted
15Sump tankCompleted
16Lift pit workCompleted
17# Ramp concreteIn Progress
18- Lower ground 2 to Lower ground 1Completed
19- Lower ground 1 to Ground floorCompleted
20# Slab workIn Progress
21- Lower ground 1 floor slabCompleted
22- Ground floor slabCompleted
23- First floor slabCompleted
24- Second floor slabCompleted
25- Third floor slabCompleted
26- 4th Floor slabCompleted
27- 5th Floor slabCompleted
28- 6th Floor slabCompleted
29- 7th Floor slabCompleted
30# Ceiling PlasteringIn Progress
31- First floorCompleted
32- Second floorCompleted
33- Third floorCompleted
34- 4th FloorCompleted
35# Block workIn Progress
36- First floorCompleted
37- Second floorIn Progress
38- Third floorCompleted
39# Inside PlasteringIn Progress
40- 1st floorIn Progress
41# Electrical workIn Progress
42- 1st floor Wall chasing and box fixingCompleted
43- 2nd floor Wall chasing and box fixingIn Progress

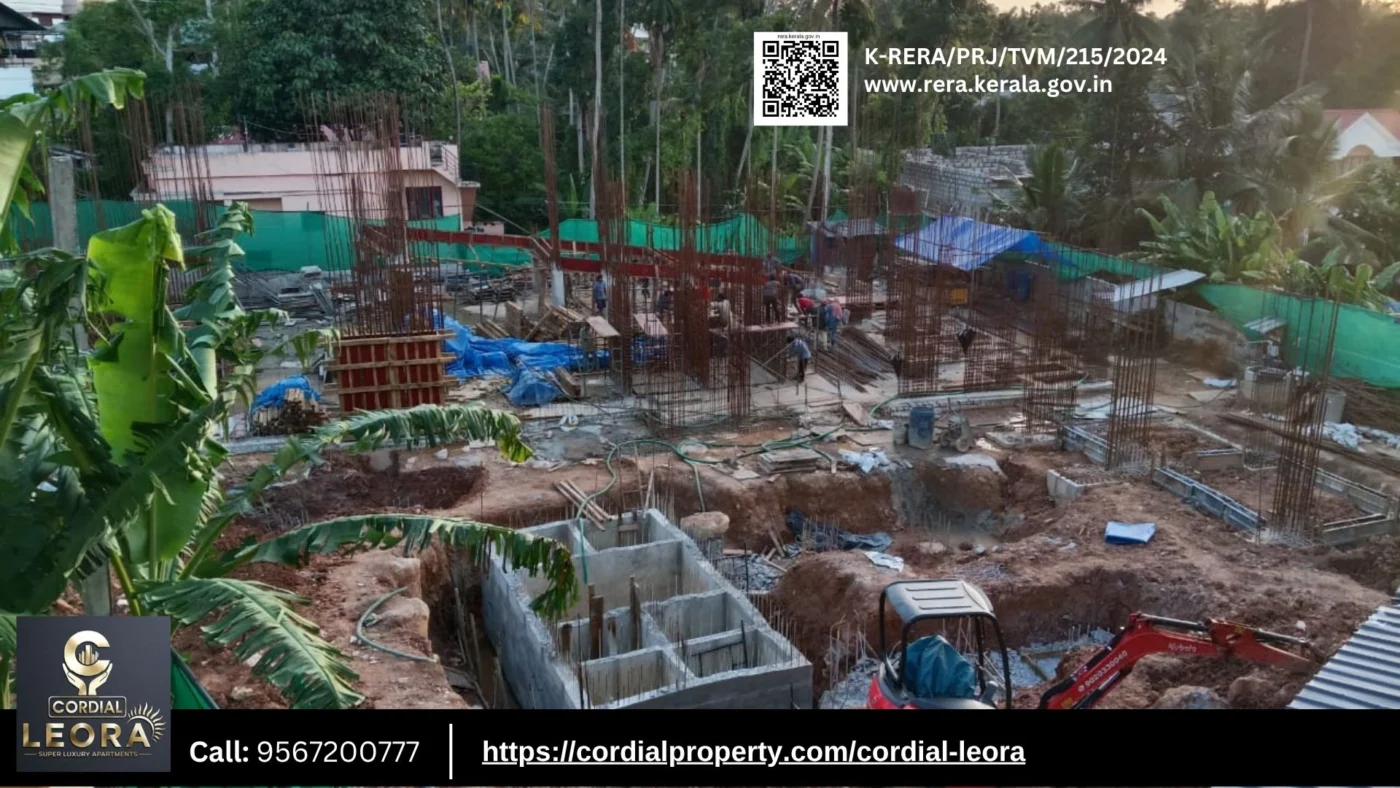

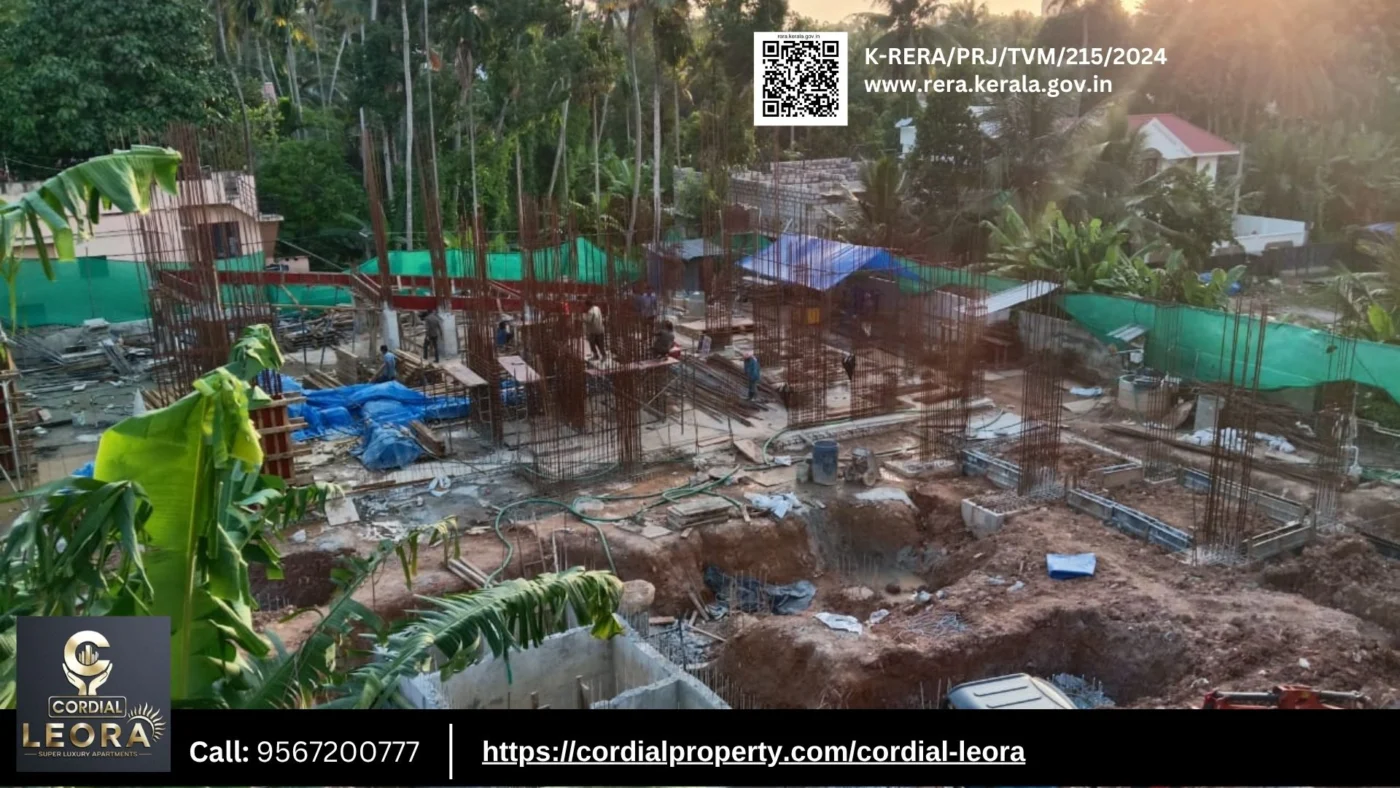

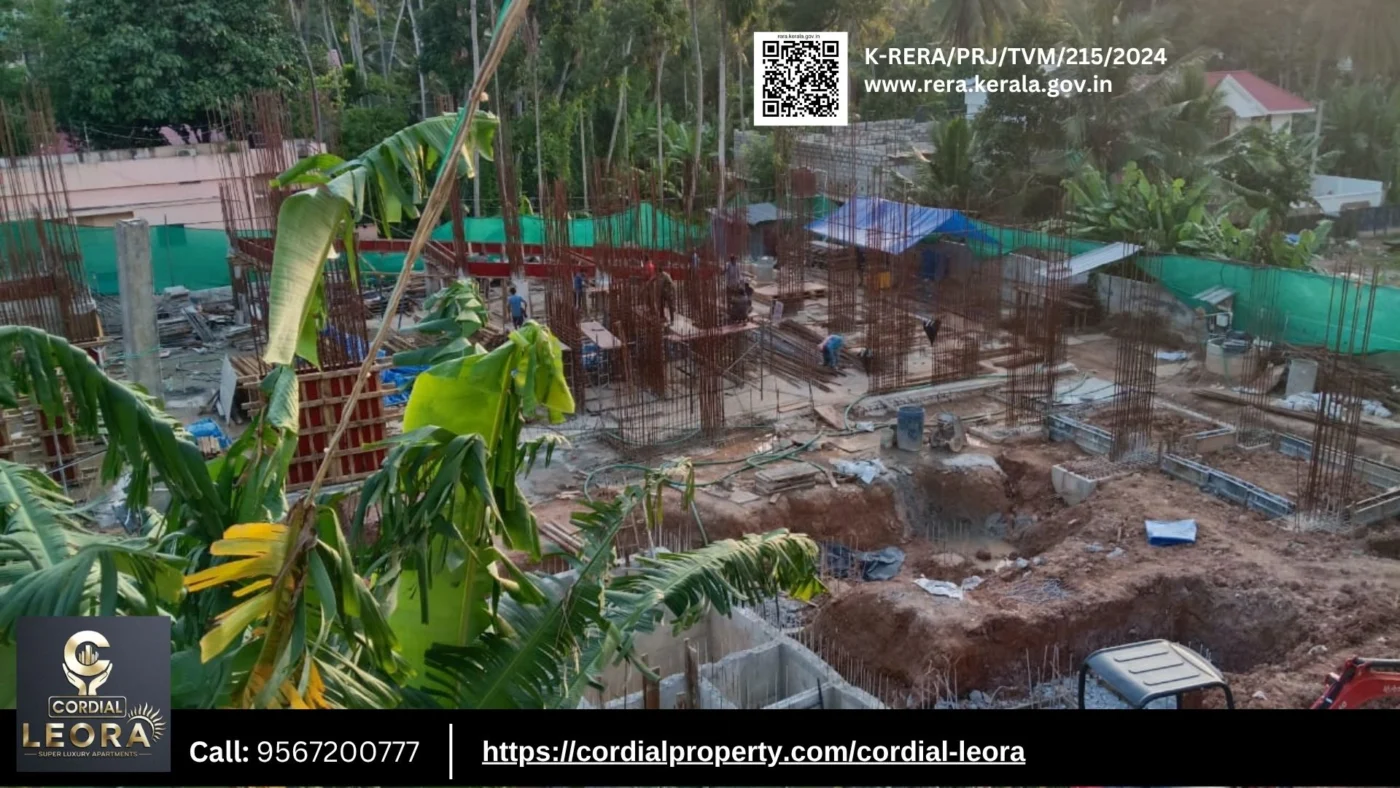

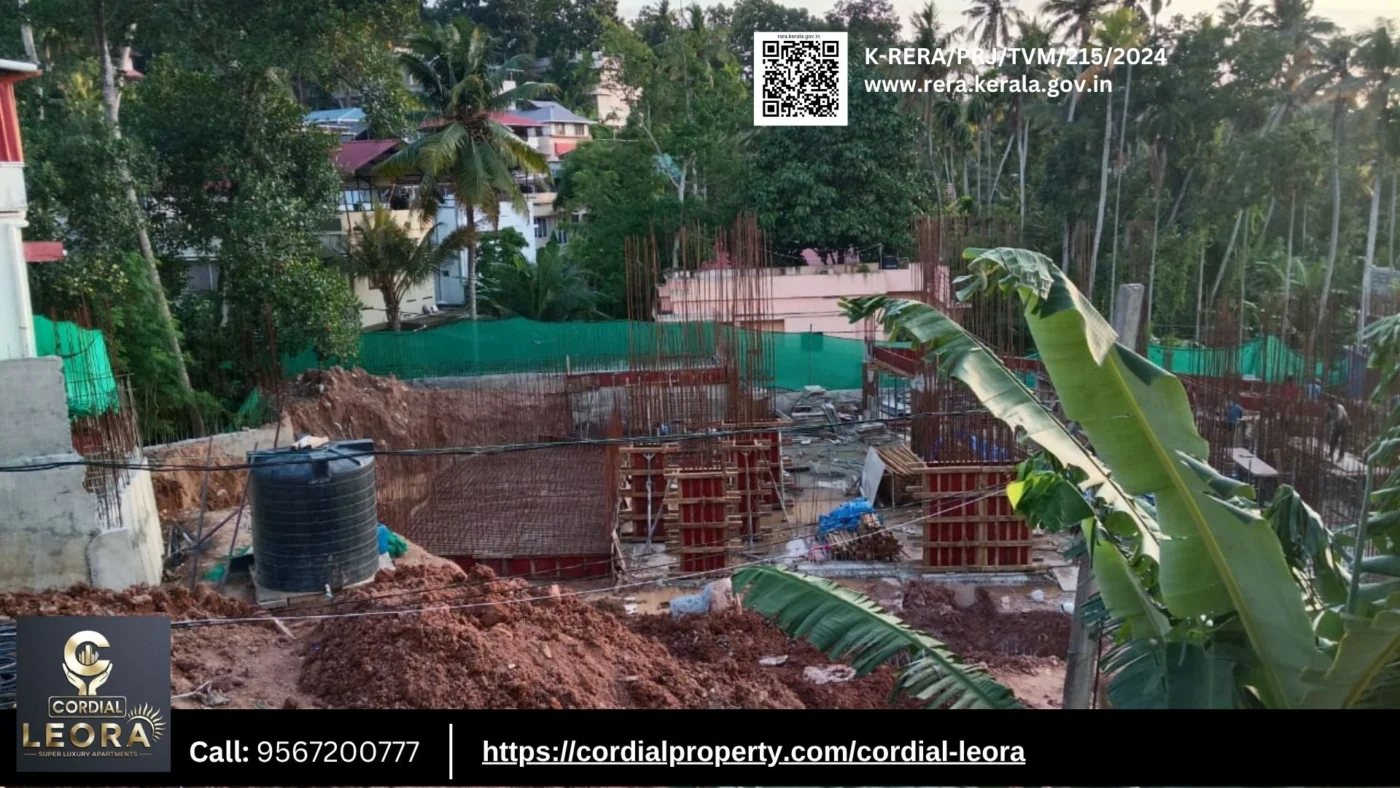

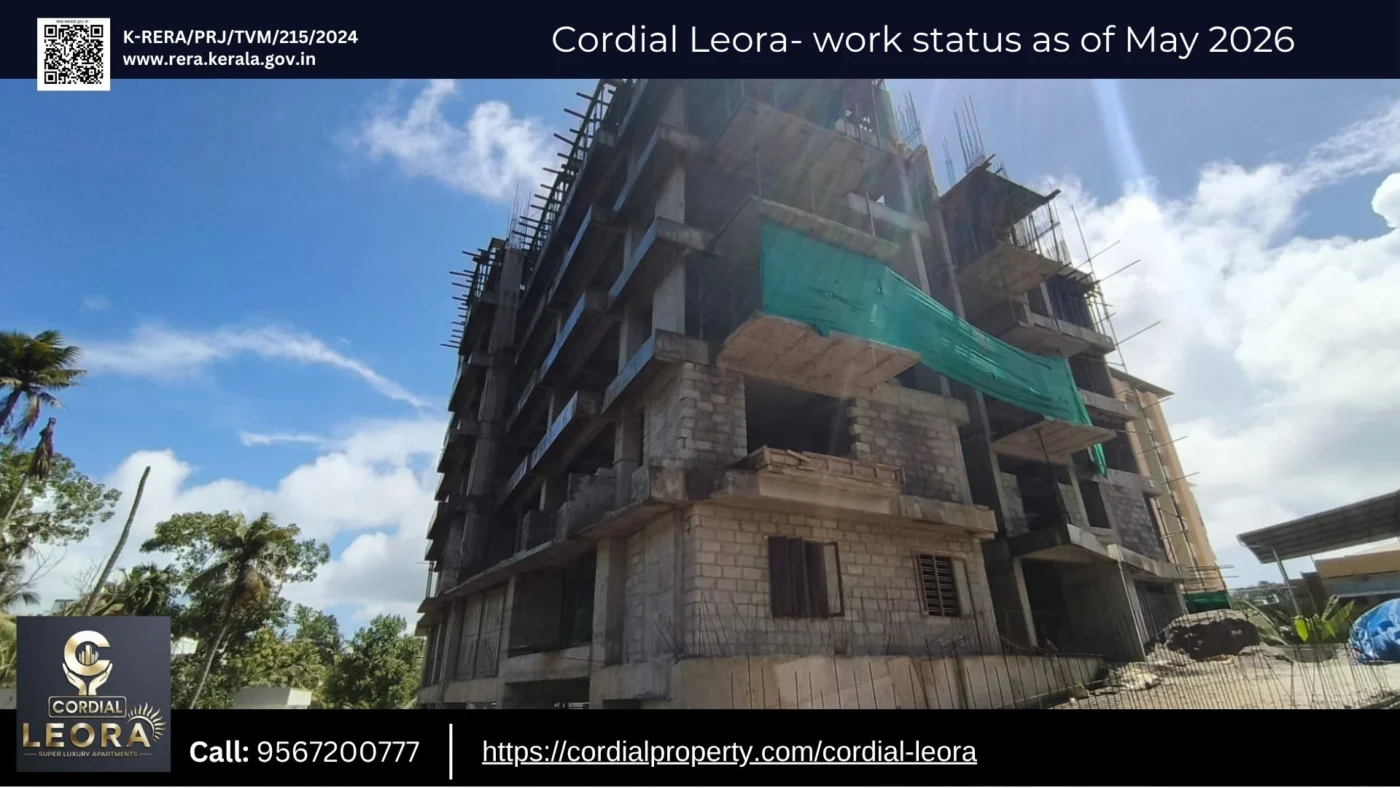

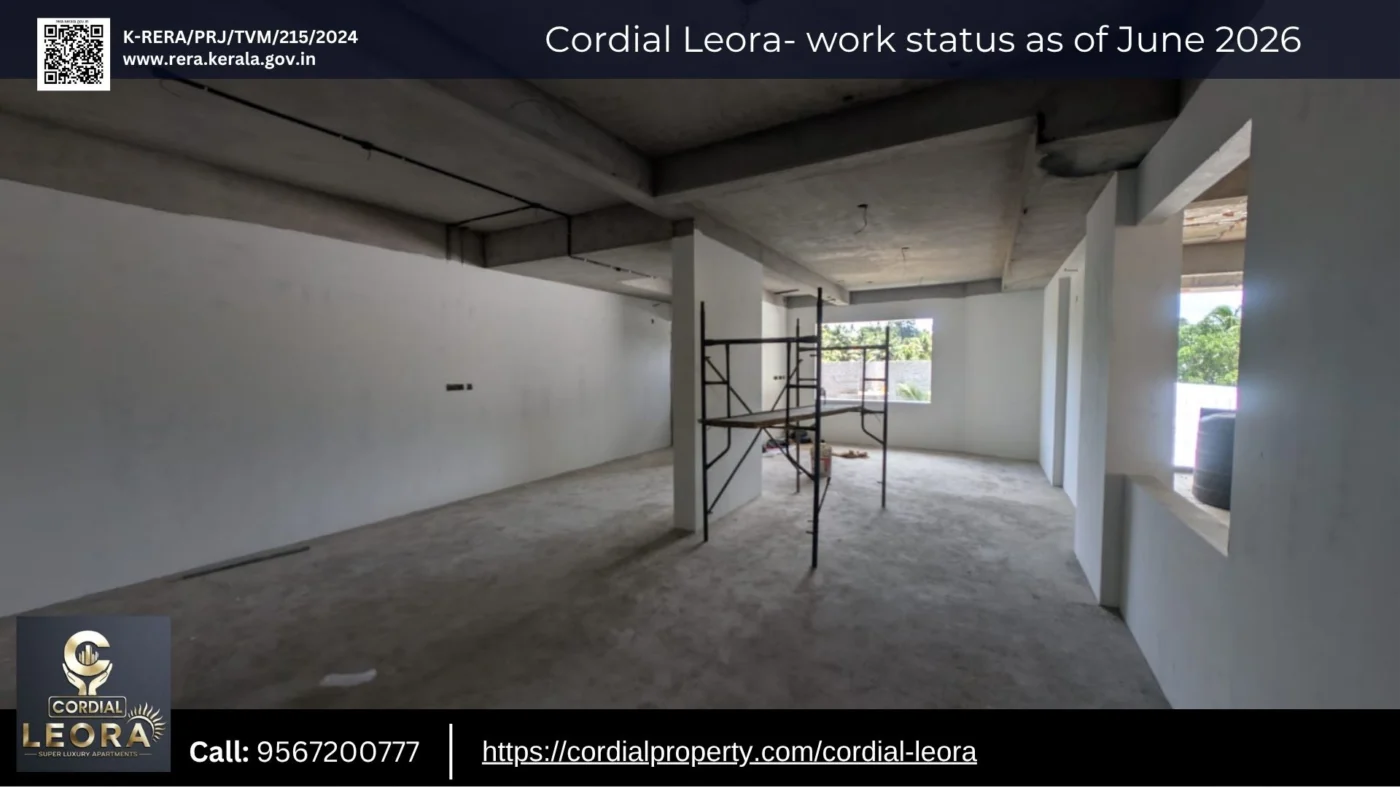

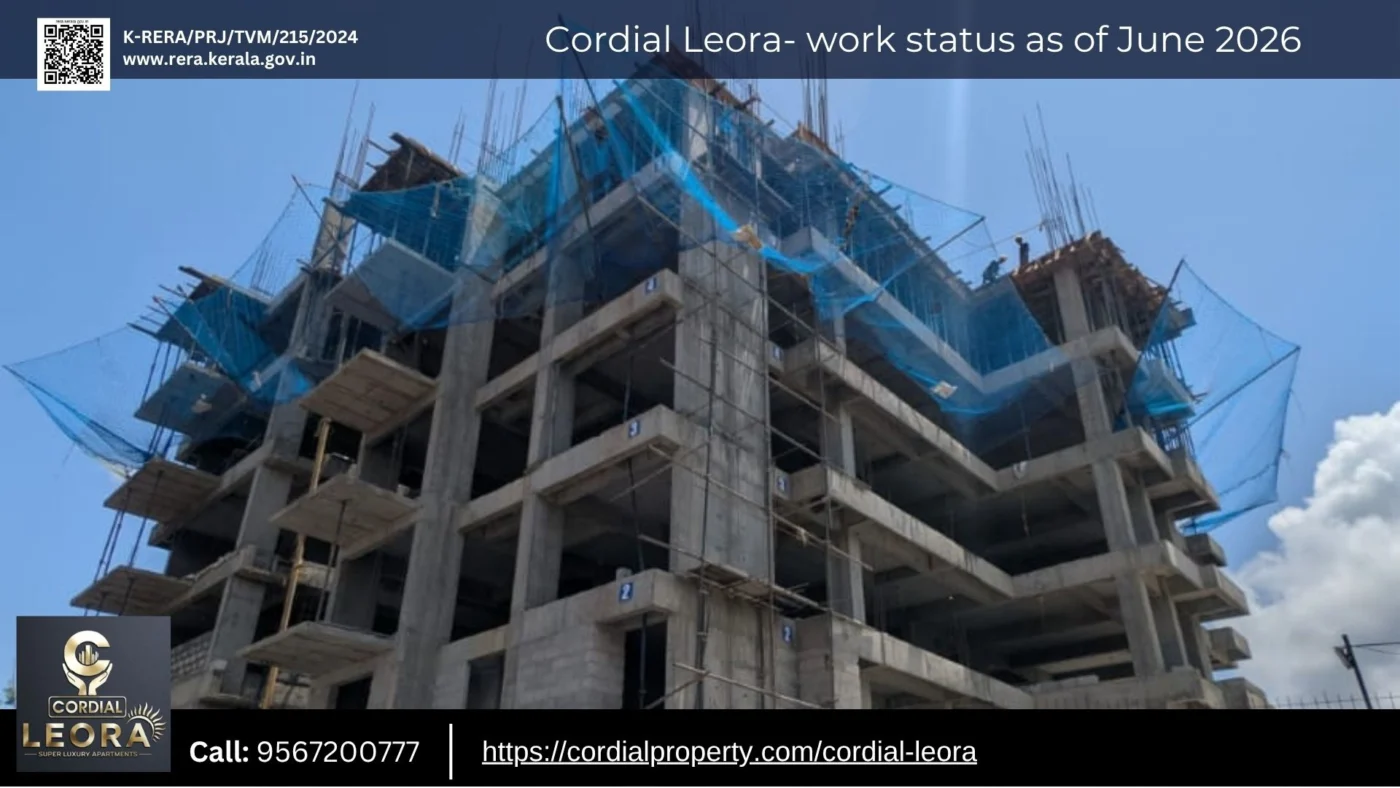

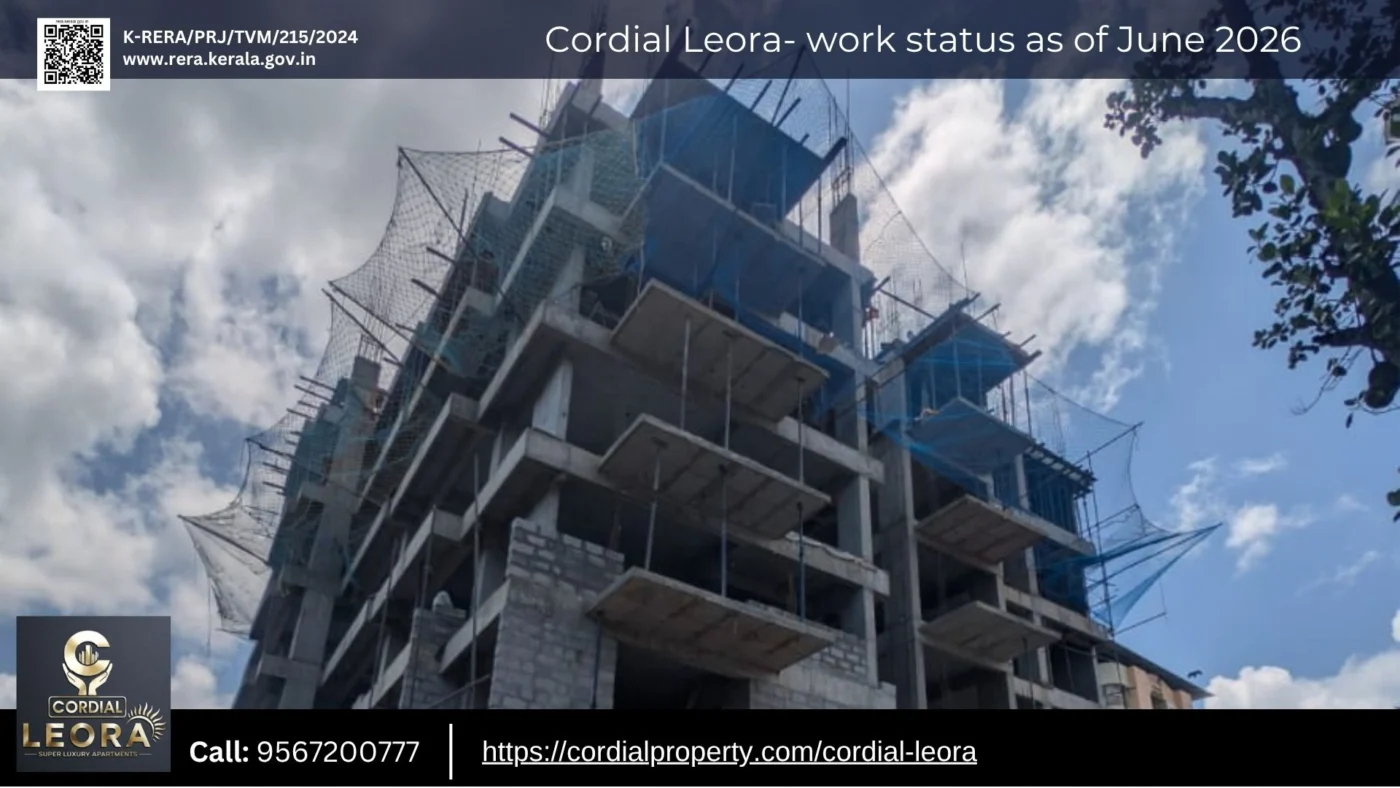

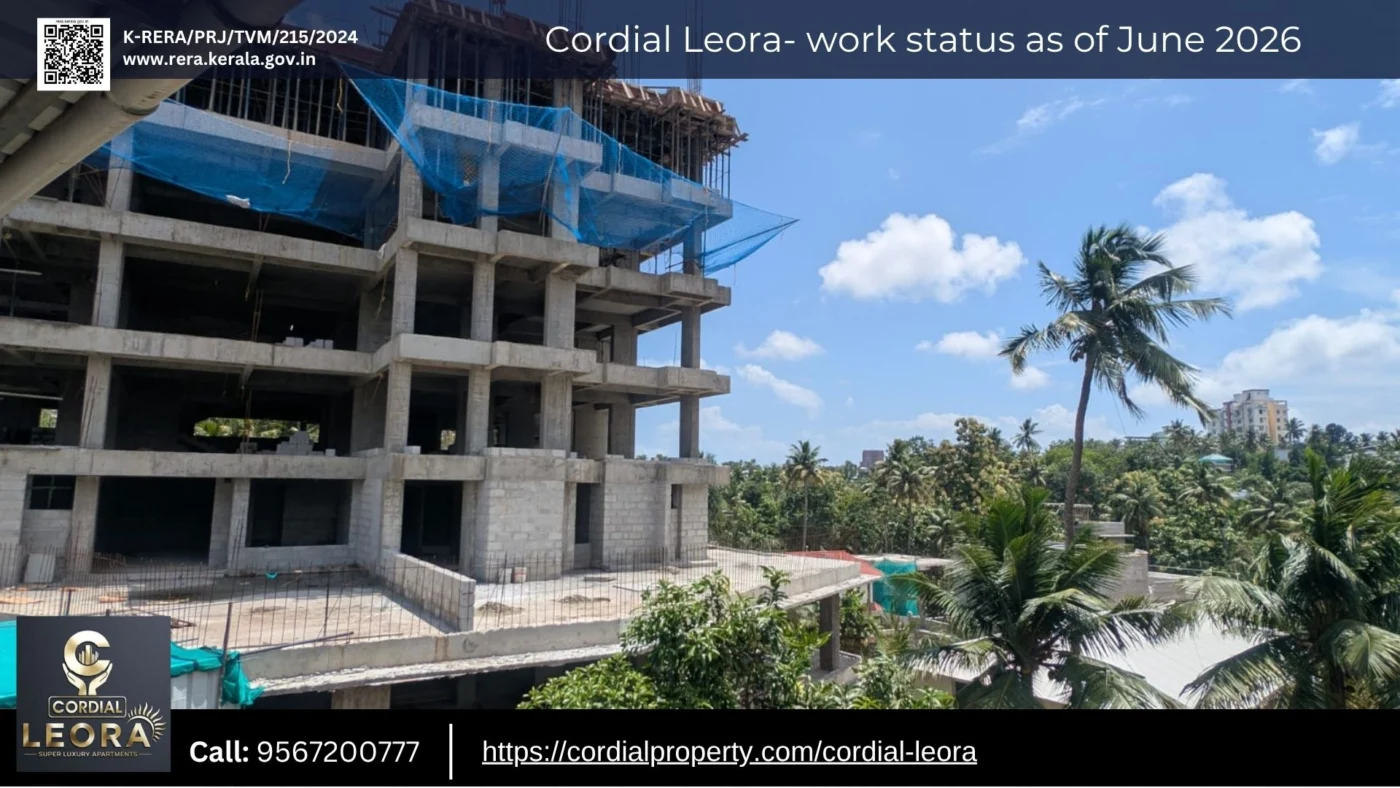

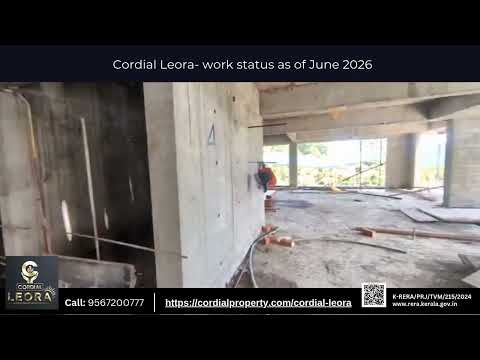

Work status as of June 2026
Sl.NoWork descriptionStatus
1Retaining wall worksCompleted
2Piling workCompleted
3Foundation including Pile cap, Grade beam and Grade slab workCompleted
4# Column workIn Progress
5- Lower ground 2 to Lower ground 1Completed
6- Lower ground 1 to Ground floorCompleted
7- Ground floor to First floorCompleted
8- First floor to Second floorCompleted
9- Second floor to Third floorCompleted
10- Third floor to 4th floorCompleted
11- 4th floor to 5th floorCompleted
12- 5th floor to 6th floorCompleted
13Sump tankCompleted
14Lift pit workCompleted

15# Ramp concreteIn Progress
16- Lower ground 2 to Lower ground 1Completed
17- Lower ground 1 to Ground floorCompleted
18# Slab workIn Progress
19- Lower ground 1 floor slabCompleted
20- Ground floor slabCompleted
21- First floor slabCompleted
22- Second floor slabCompleted
23- Third floor slabCompleted
24- 4th Floor slabCompleted
25- 5th Floor slabCompleted
26# Ceiling PlasteringIn Progress
27- First floorCompleted
28- Second floorCompleted
29# Block workIn Progress
30- First floorCompleted
