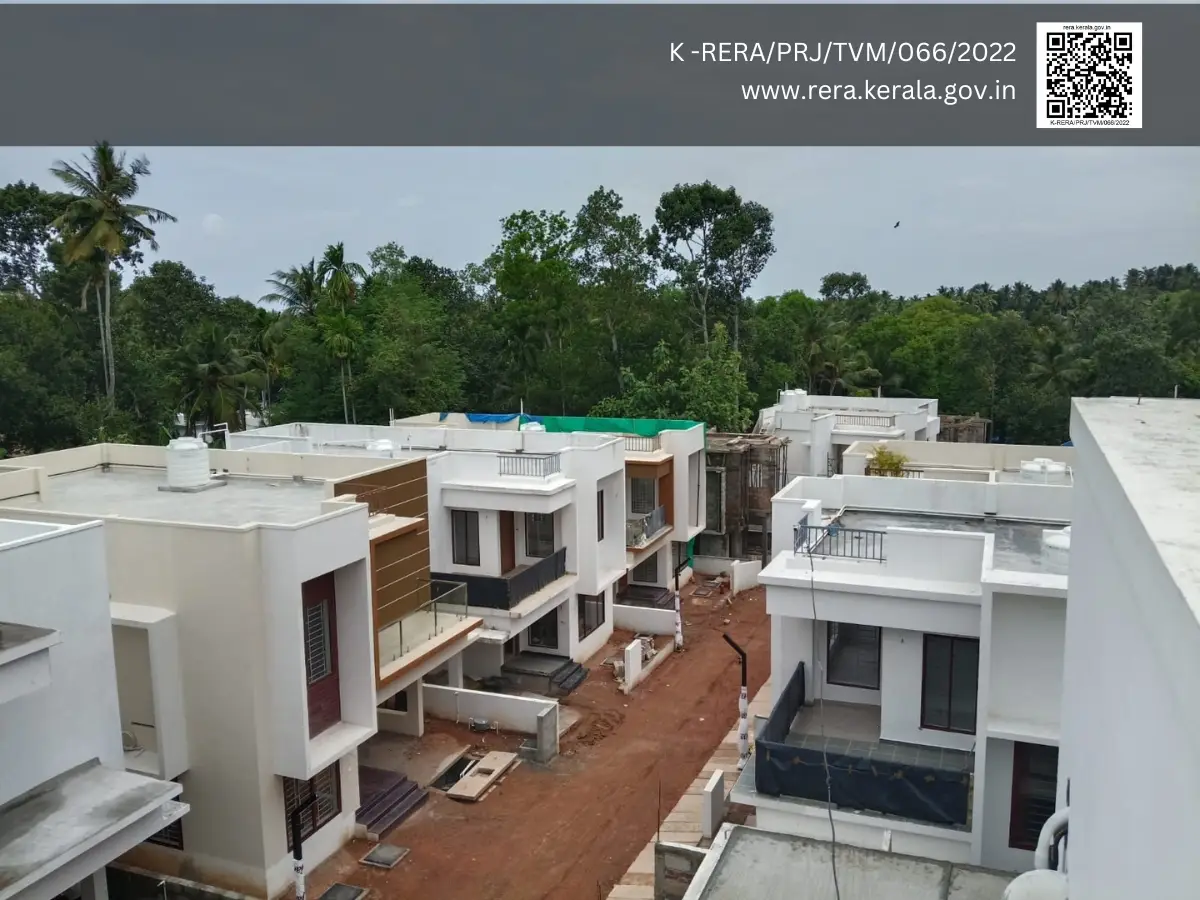

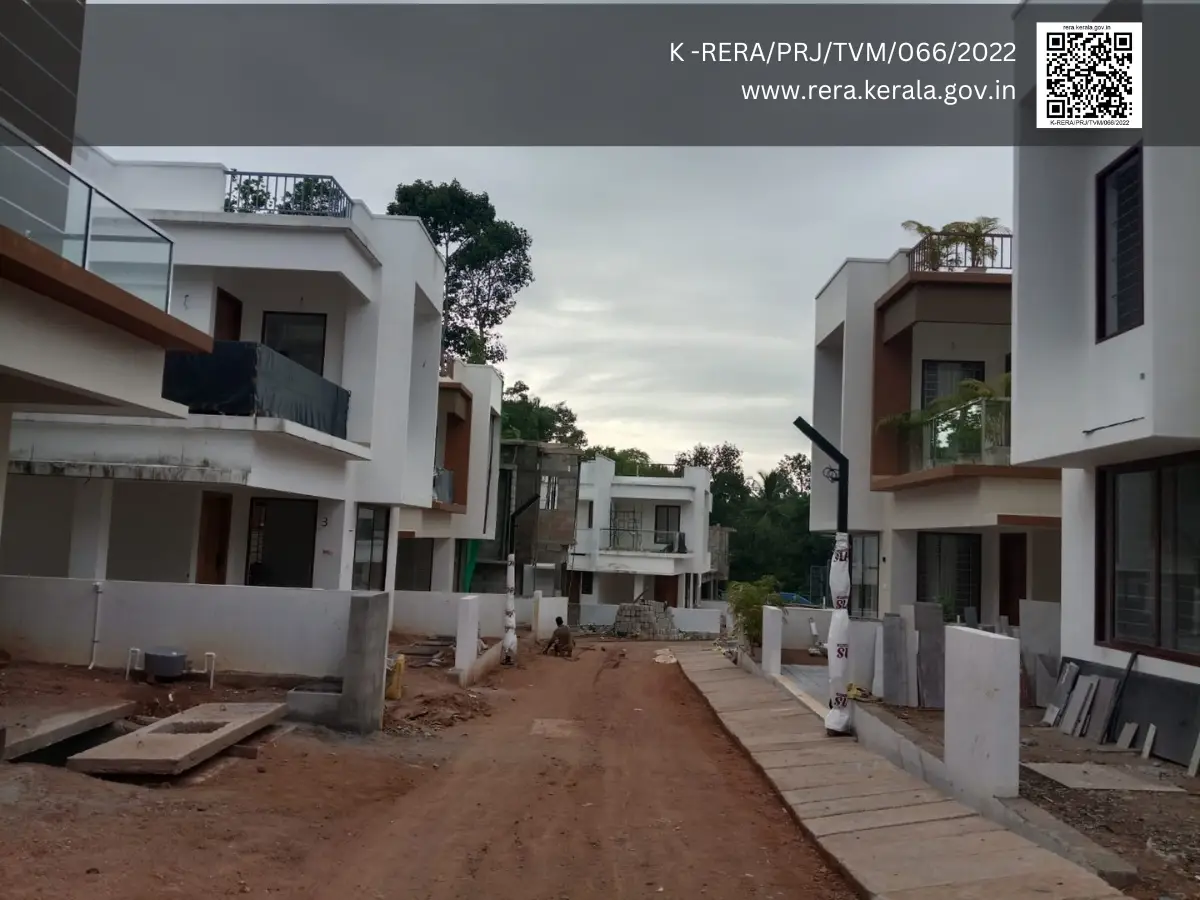

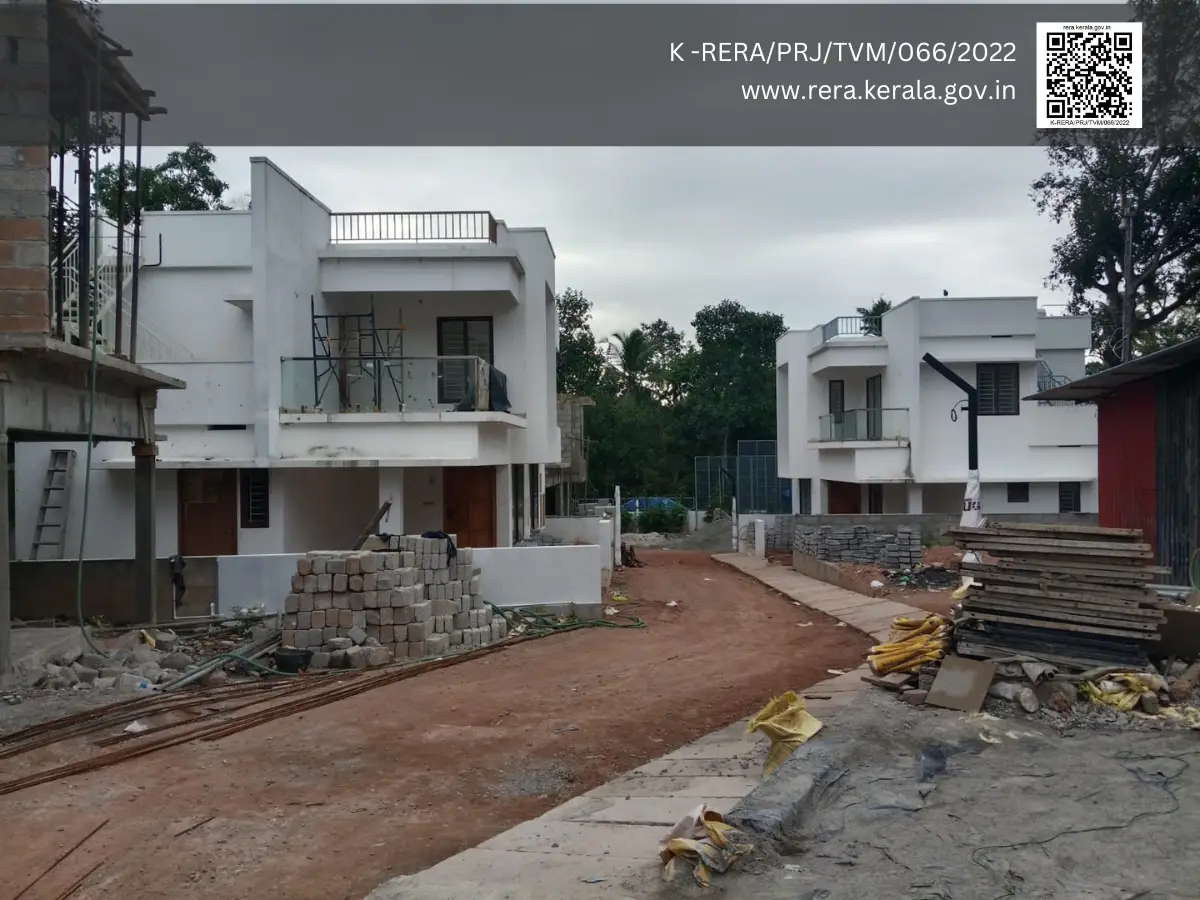

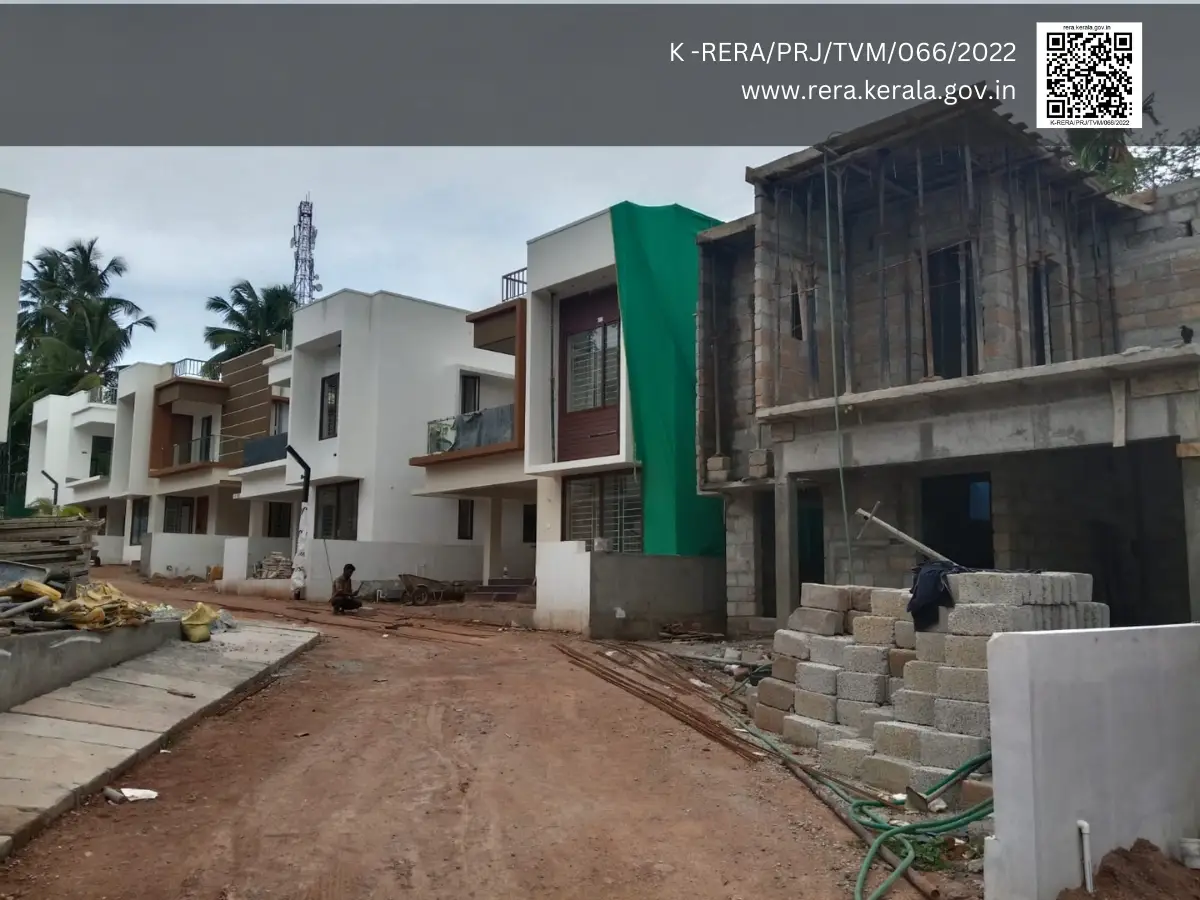

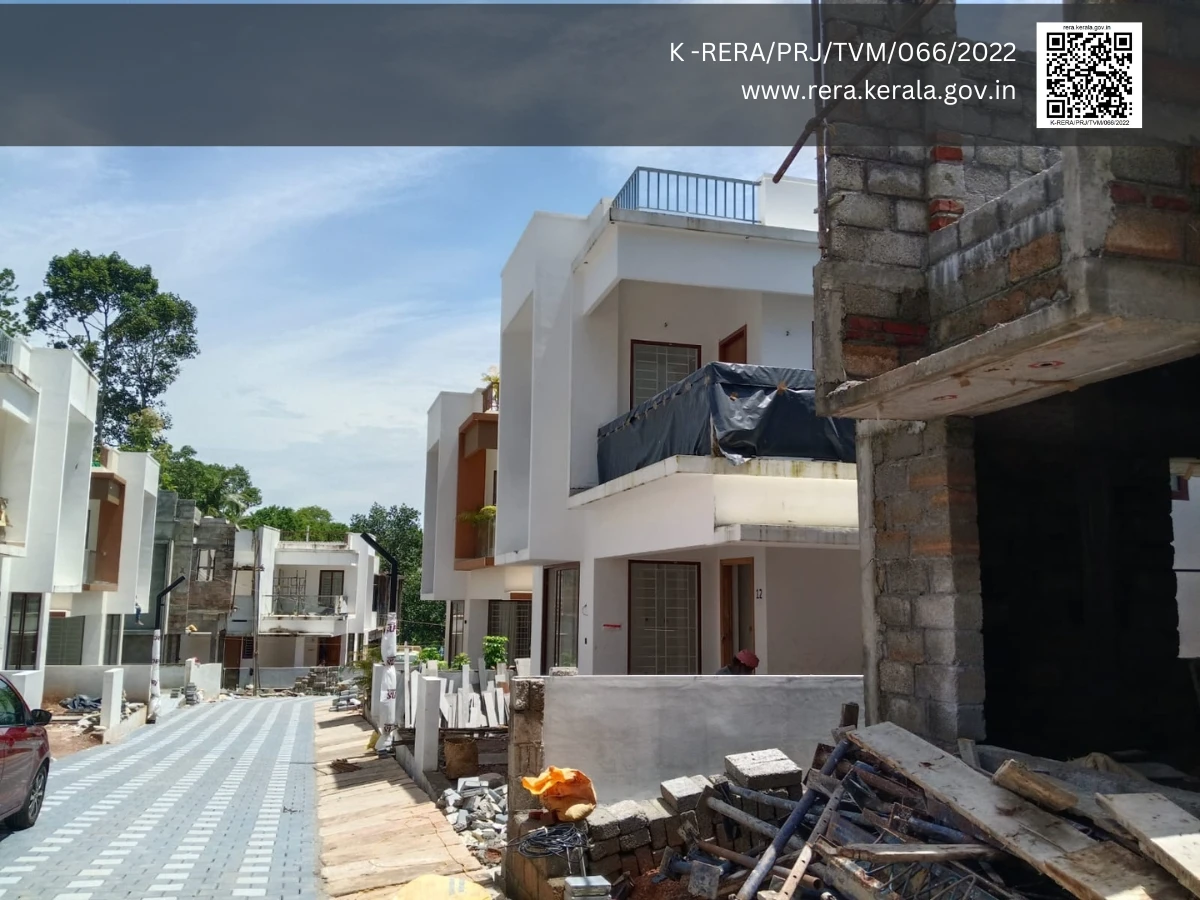

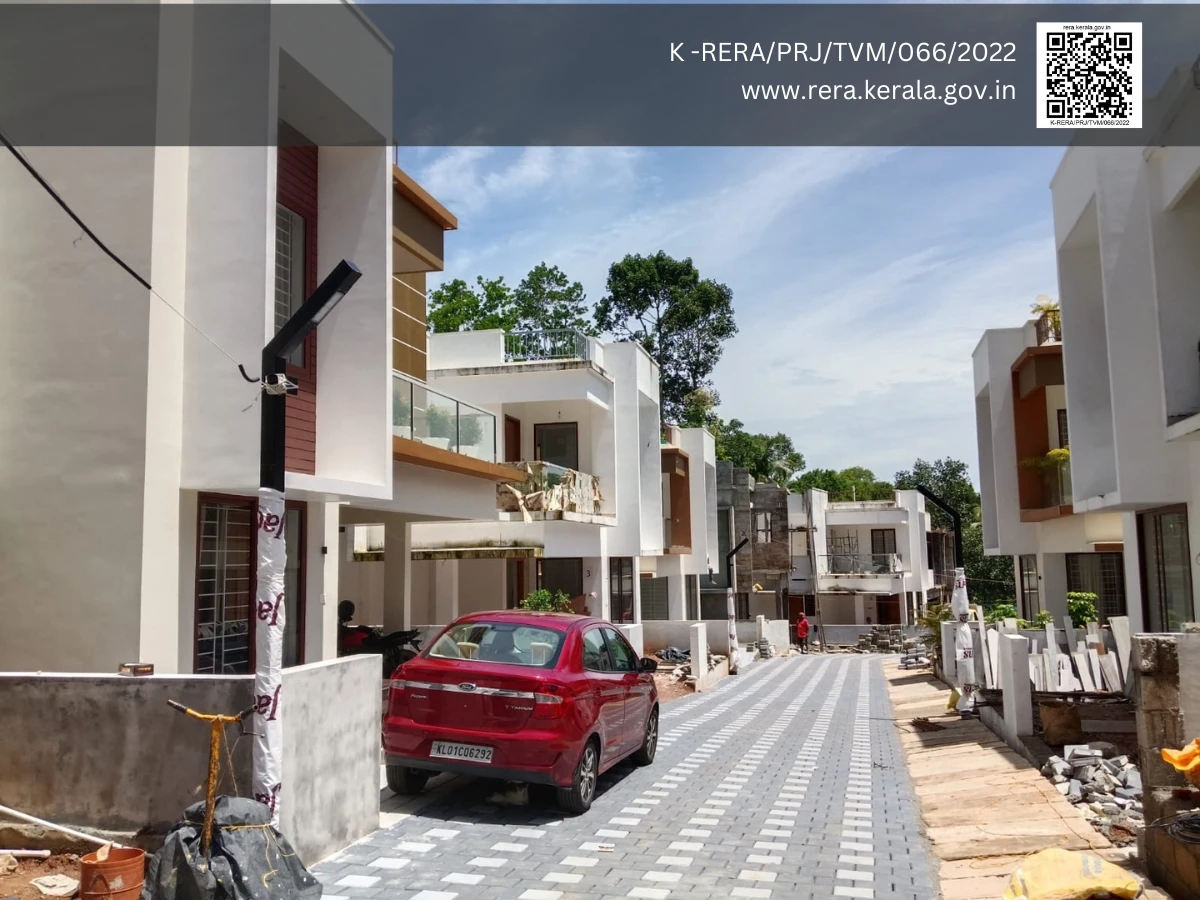

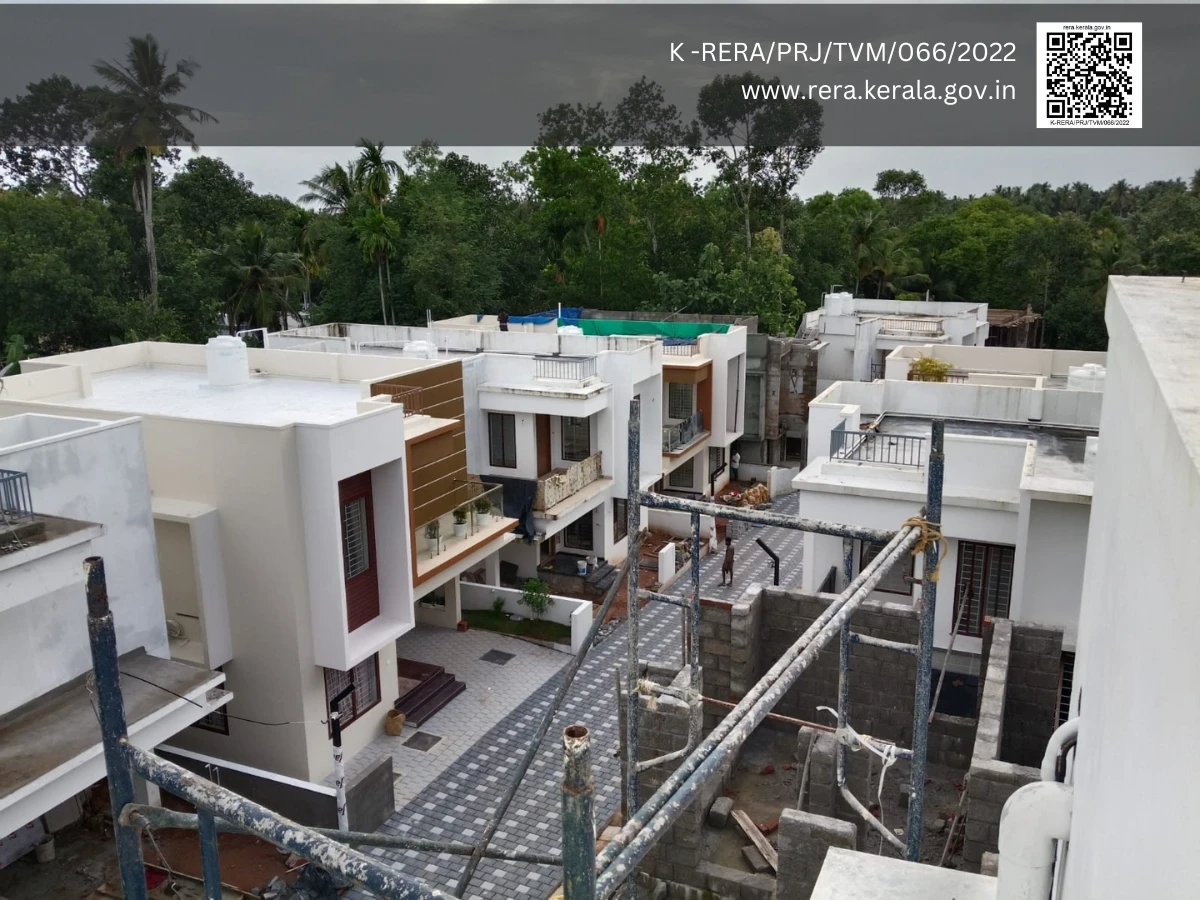

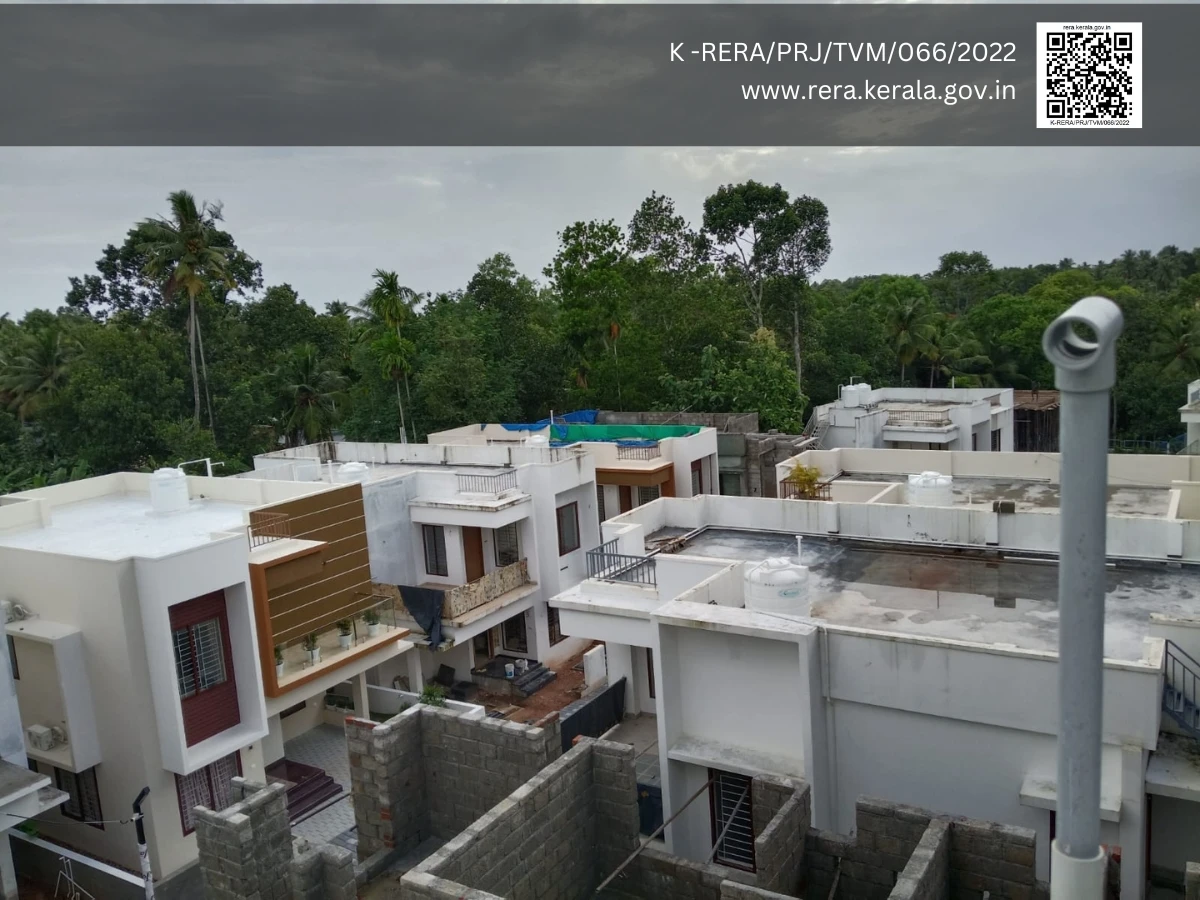

Cordial I-Nest-Work status

I-Nest-October 2025

1.Common area

  • Land development works- 100% Completed
  • Electrical works – 95% Completed
  • Plumbing works – 100% Completed
  • Interlock laying in common area – 80% Completed

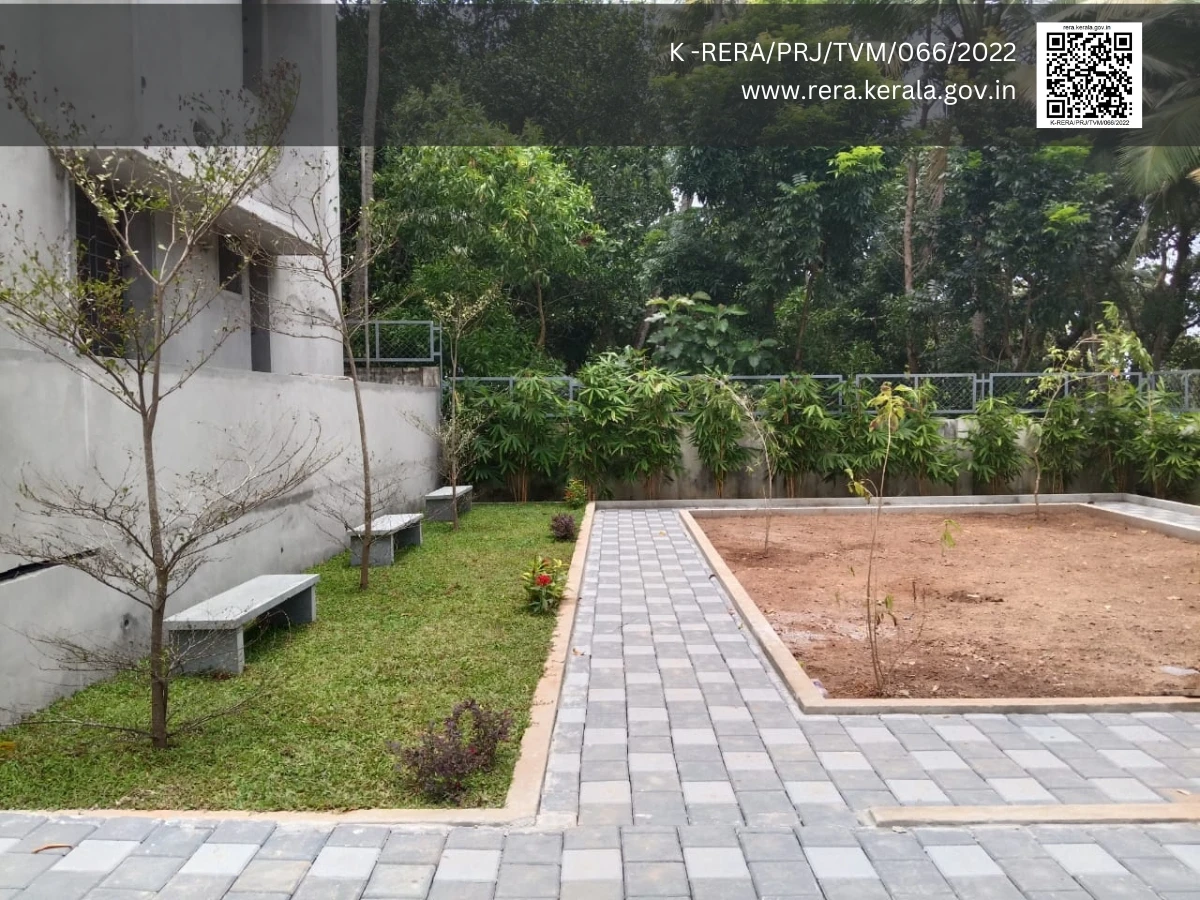

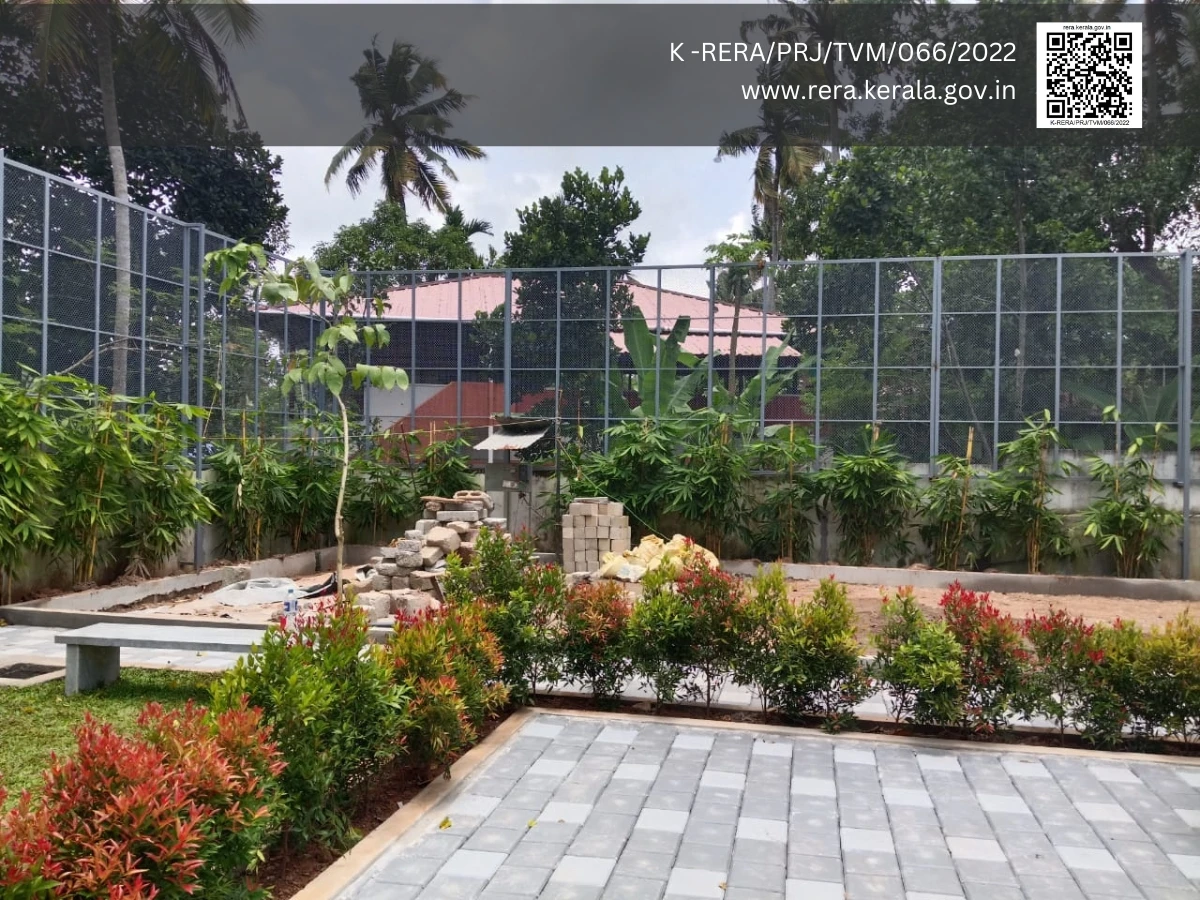

  • Recreation area landscaping – 100% Completed
  • AC Multipurpose hall – 100% completed
  • AC Health Club- 100% completed
  • Outdoor children’s play area- 100% completed

2.Plot 1 – 85% Completed

3.Plot 2 – Completed & OC Obtained

4.Plot 3 – Completed & OC Obtained

5.Plot 4 – Completed & OC Obtained

6.Plot 5 – 70% Completed

7.Plot 6 – Completed & OC Obtained

8.Plot 7 – 70 % Completed

9.Plot 8 – Completed & OC Obtained

  1. Plot 9 – 25% Completed
  2. Plot 10 – 15% Completed

12.Plot 11 – Completed & OC Obtained

13.Plot 12 – Completed & OC Obtained

14.Plot 13 – 50% Completed

15.Plot 14 – Completed & OC Obtained

I-Nest- August 2025

  • Villa 1- 80% completed
  • Villa 2- Completed and OC Obtained
  • Villa 3- Completed and OC Obtained
  • Villa 4- Completed and OC Obtained
  • Villa 5- 70% completed
  • Villa 6- Completed and OC Obtained
  • Villa 7- 70% completed
  • Villa 8- Completed and OC Obtained
  • Villa 9- Ground Floor Block work in progress
  • Villa 10- Footing and Foundation works completed
  • Villa 11- Completed and OC Obtained
  • Villa 12- Completed and OC Obtained
  • Villa 13- Internal and External plastering in progress
  • Recreation Block- Completed and OC Obtained
  • Roads and Landscape works- Completed
  • Badminton court and Children’s play area- Works in Progress

I-Nest- June 2025

  • Common area
    Land development works- 100% Completed
    Electrical works – 75% Completed
    Plumbing works – 85% Completed
    Interlock laying in common area – 80% Completed
    Recreation area landscaping – 60% Completed
  • Plot 1 – 75% Completed
  • Plot 2 – Completed & OC Obtained
  • Plot 3 – Completed & OC Obtained
  • Plot 4 – Completed & OC Obtained
  • Plot 5 – 50% Completed
  • Plot 6 – Completed & OC Obtained
  • Plot 7 – 40 % Completed
  • Plot 8 – Completed & OC Obtained
  • Plot 9 – 15% Completed
  • Plot 10 – 5% Completed
  • Plot 11 – Completed & OC Obtained
  • Plot 12 – 90% Completed
  • Plot 13 – 35% Completed
  • Plot 14 – Completed & OC Obtained

Inest as of May 20, 2025

As of May 20, 2025, all villas at Cordial I-Nest are in the finishing stage, with several already handed over to proud owners.

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

Inest as of April 20, 2025

As of April 20, 2025, all villas at Cordial I-Nest are in the finishing stage, with several already handed over to proud owners.

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

Inest as of March 31, 2025

As of March 31, 2025, all villas at Cordial I-Nest are in the finishing stage, with several already handed over to proud owners.

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

I-NEST- May 2024

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

I-Nest- April 2024

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

As of February 2024

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

I-Nest as of December 2023

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

As of October 2023

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

Cordial I-Nest- as of August 2023

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing and electrical – work in progress

Cordial I-Nest as of June 2023

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress
  • Club House plumbing – work in progress

Cordial I-Nest- May 2023

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress

February 2023

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – Completed
  • Individual villas – Work in progress

I-Nest As of December 2022

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Structure – Completed
  • Club House Plastering – In progress
  • Individual villas – Work in progress

I-Nest September 2022

  • Land Development Works – Completed
  • Plot Division – Completed
  • Retaining Walls – Completed
  • Club House Foundation  – Completed
  • Club House Ground Floor Structure – Completed
